A practical engineering and procurement framework for transferring PCB/PCBA production without introducing avoidable quality, supply-chain, documentation, cost or delivery risk

Changing a PCB or PCBA manufacturing supplier is rarely just a matter of sending the same files to a different factory.
The design may be unchanged.
The BOM may appear unchanged.
The finished product may look identical.
Yet the manufacturing process behind that product can change significantly.
Different suppliers may use different:
Manufacturing processes
Material sources
Component sourcing channels
Stencils
Reflow profiles
Inspection strategies
Test methods
Work instructions
Equipment
Process controls
Quality systems
Documentation practices
That means a supplier transfer can introduce risk even when the product design itself has not changed.
The safest approach is therefore not:
"Move the files and see whether the new supplier can build it."
It is:
"Control the transfer as an engineering and manufacturing change."
This article explains how.
A production transfer can affect multiple parts of the manufacturing system simultaneously.
Consider a typical PCBA:
→ PCB fabrication
→ Component sourcing
→ SMT assembly
→ THT assembly
→ Reflow / soldering
→ Inspection
→ Testing
→ Programming
→ Final inspection
Even when the design remains unchanged, the processes used to produce the board can change.
Potential risks include:
Technical risk
The new supplier may interpret manufacturing data differently or identify previously tolerated design characteristics as manufacturing constraints.
Quality risk
Different processes or controls can produce different defect rates, soldering results or assembly consistency.
Component risk
The new supplier may source components through different channels or encounter different availability conditions.
Testing risk
Existing test fixtures, programs or procedures may not transfer cleanly.
Documentation risk
Incomplete or outdated manufacturing documentation can create ambiguity.
Delivery risk
The new supplier may require more time than expected for engineering setup, component procurement or process qualification.
Cost risk
The quoted unit price may not represent the complete transition and production cost.
A supplier transfer should therefore be treated as a controlled manufacturing transition, not merely a purchasing decision.
Before starting the transfer, clearly document the reason for the change.
Common reasons include:
Capacity constraints
Cost reduction
Lead-time problems
Quality issues
Geographic diversification
Supply-chain resilience
Engineering support requirements
Technology requirements
End-of-life supplier relationship
Need for higher production volumes
Need for a new regional manufacturing base
This matters because the reason for the transfer should determine what you validate most carefully.
For example:
If the primary problem is quality, quality and process validation deserve particular attention.
If the primary problem is capacity, production scalability and capacity planning become critical.
If the primary problem is supply continuity, component sourcing and supply-chain resilience should receive greater emphasis.

A controlled supplier transfer should have a defined plan.
At minimum, identify:
What is being transferred?
Which documents are available?
What is changing?
What must remain unchanged?
Which components are critical?
Which processes require validation?
What testing is required?
What constitutes a successful pilot?
Who approves the transfer?
When can production be released?
This converts an open-ended supplier change into a manageable project.
Before transferring production, establish exactly what is being manufactured.
This is your baseline.
The baseline should identify the approved versions of relevant manufacturing information, such as:
PCB fabrication data
Assembly data
BOM
Pick-and-place files
Drawings
Assembly instructions
Test specifications
Programming requirements
Approved component information
Revision history
Special process requirements
Without a controlled baseline, it becomes difficult to determine whether a problem came from:
The original design
The transfer
The new supplier's process
An undocumented change
A clean baseline creates a reference point.
One of the most important steps in a supplier transfer is reviewing the manufacturing package.
A design team may believe it has supplied "everything."
But production may depend on information that was previously communicated informally.
For example:
Supplier-specific work instructions
Special inspection requirements
Approved component alternates
Assembly notes
Test procedures
Programming instructions
Packaging requirements
Special handling instructions
When moving to a new supplier, these hidden dependencies need to become explicit.
The BOM deserves particular attention.
Do not simply send the existing BOM to the new supplier and assume it will be sourced identically.
Review:
Manufacturer part numbers
Approved manufacturers
Component descriptions
Package information
Lifecycle status
Availability
Lead time
Critical components
Approved alternates
Customer-specific restrictions
A supplier transfer is an opportunity to identify BOM risks that may have been hidden by the previous supplier's sourcing process.
Not every component deserves the same level of attention.
Identify components where substitution or sourcing failure could create significant risk.
Examples can include:
Microcontrollers
Processors
Memory
Power semiconductors
RF components
Sensors
Connectors
Safety-critical components
Long-lead components
Proprietary components
For each critical component, understand:
Source → Availability → Lifecycle → Alternate strategy → Approval requirement
One of the most important rules during a supplier transition is:
Do not allow an uncontrolled component substitution simply because the new supplier can source it.
A component that appears similar may differ in:
Electrical characteristics
Thermal characteristics
Tolerance
Package dimensions
Pin configuration
Firmware compatibility
Reliability
Regulatory status
Mechanical fit
If an alternate is necessary, define the approval process before production.
Even if the PCB has already been manufactured successfully, a new supplier should perform its own manufacturing review.
Why?
Because manufacturing processes differ.
The new supplier may have different:
Equipment
Process windows
Material systems
Stencil processes
Panelization methods
Assembly capabilities
Fabrication capabilities
The objective is not to redesign the board unnecessarily.
It is to identify whether the existing design creates any manufacturing risk in the new production environment.
For PCB fabrication, compare the existing and proposed manufacturing approaches.
Review:
Material
Stack-up
Board thickness
Copper weight
Surface finish
Layer construction
Via technology
Controlled impedance
Dimensional tolerances
Panelization
Special fabrication requirements
If the product has controlled impedance or other critical PCB characteristics, ensure that the new supplier understands and can control the relevant requirements.
The same PCBA can be assembled using different process configurations.
Review:
Stencil design
Solder-paste process
Component placement
Reflow profile
THT process
Selective soldering
Cleaning
Inspection
Rework
The goal is not to force the new supplier to reproduce every historical process parameter.
The goal is to ensure that the validated manufacturing outcome remains equivalent to the product requirement.

Testing is sometimes overlooked during supplier transfers.
That can be a serious mistake.
Determine what testing is required and how it will be reproduced.
This may include:
AOI
X-ray
ICT
Flying probe
Functional testing
Electrical testing
Programming
Firmware loading
Calibration
If the existing supplier uses a custom test fixture or test software, determine exactly what needs to be transferred.
The new supplier needs to understand what constitutes an acceptable product.
Define the applicable:
Specifications
Acceptance criteria
Inspection requirements
Test requirements
Workmanship requirements
Defect classification
Documentation requirements
Where appropriate, use objective acceptance criteria rather than informal descriptions such as:
"The previous supplier always built it this way."
The new supplier needs requirements that can be understood, measured and controlled.
The previous supplier may possess valuable manufacturing knowledge.
For example:
Known process sensitivities
Recurring defects
Difficult components
Special assembly considerations
Historical corrective actions
Known-good process parameters
Where this information is available and appropriate to share, incorporate it into the transfer.
This can significantly reduce the learning curve.
A supplier transition should not mean throwing away years of accumulated manufacturing knowledge.
Determine what production information must be traceable.
Depending on the product, this may include:
PCB lot
Component manufacturer
Component lot/date code
Assembly batch
Test results
Production date
Operator/process information
Firmware version
Serial number
The required level of traceability should be defined before production starts.
One of the strongest ways to reduce transfer risk is to avoid going directly from:
Old Supplier → Full Production at New Supplier
Instead:
Old Supplier → New Supplier Pilot → Validation → Production Release
The pilot build gives the engineering and manufacturing teams an opportunity to identify problems while the production quantity and exposure are still limited.
A pilot should not simply answer:
"Did the supplier produce the boards?"
It should answer:
"Has the new manufacturing process demonstrated that it can repeatedly produce an acceptable product?"
Depending on the product, evaluate:
PCB
Dimensional conformity
Stack-up
Surface finish
Electrical testing
Impedance where applicable
PCBA
Placement
Solder quality
Component orientation
BGA/fine-pitch quality
AOI results
X-ray results where applicable
Testing
Electrical performance
Functional testing
Programming
Calibration where applicable
Production
Yield
Rework
Defects
Cycle time
Documentation
Traceability
Where historical production data is available, compare the new supplier's results against it.
For example:
Metric | Existing Supplier | New Supplier Pilot | Assessment |
|---|---|---|---|
First-pass yield | — | — | — |
Defect rate | — | — | — |
Rework | — | — | — |
Test failures | — | — | — |
Delivery | — | — | — |
Component shortages | — | — | — |
The actual metrics will vary by product and manufacturing process.
The important principle is to compare equivalent measurements.
A pilot build is supposed to expose problems.
Finding issues does not necessarily mean the supplier is unsuitable.
Instead, classify them.
Category A — Critical
Problems affecting safety, functionality, regulatory compliance or fundamental product performance.
Category B — Major
Problems requiring process or engineering correction before production release.
Category C — Minor
Issues that can be corrected without affecting product functionality or production readiness.
Then assign:
Issue → Root cause → Corrective action → Owner → Verification → Closure
A technically successful pilot can still fail because components are unavailable.
Before production release, confirm:
Critical component availability
Procurement lead times
Approved sourcing channels
Alternates
Allocation risks
Lifecycle risks
Required customer approvals
The production plan should reflect actual component availability, not only the PCB assembly capacity.
The pilot may involve 20, 50 or 100 boards.
Production may require thousands.
Ask whether the supplier's process can scale.
Review:
SMT capacity
PCB supply
Component procurement
Production staffing
Test capacity
Inspection capacity
Scheduling
Material storage
Capacity planning
A successful pilot proves technical feasibility.
It does not automatically prove production scalability.

A supplier may quote:
"10-day PCBA lead time."

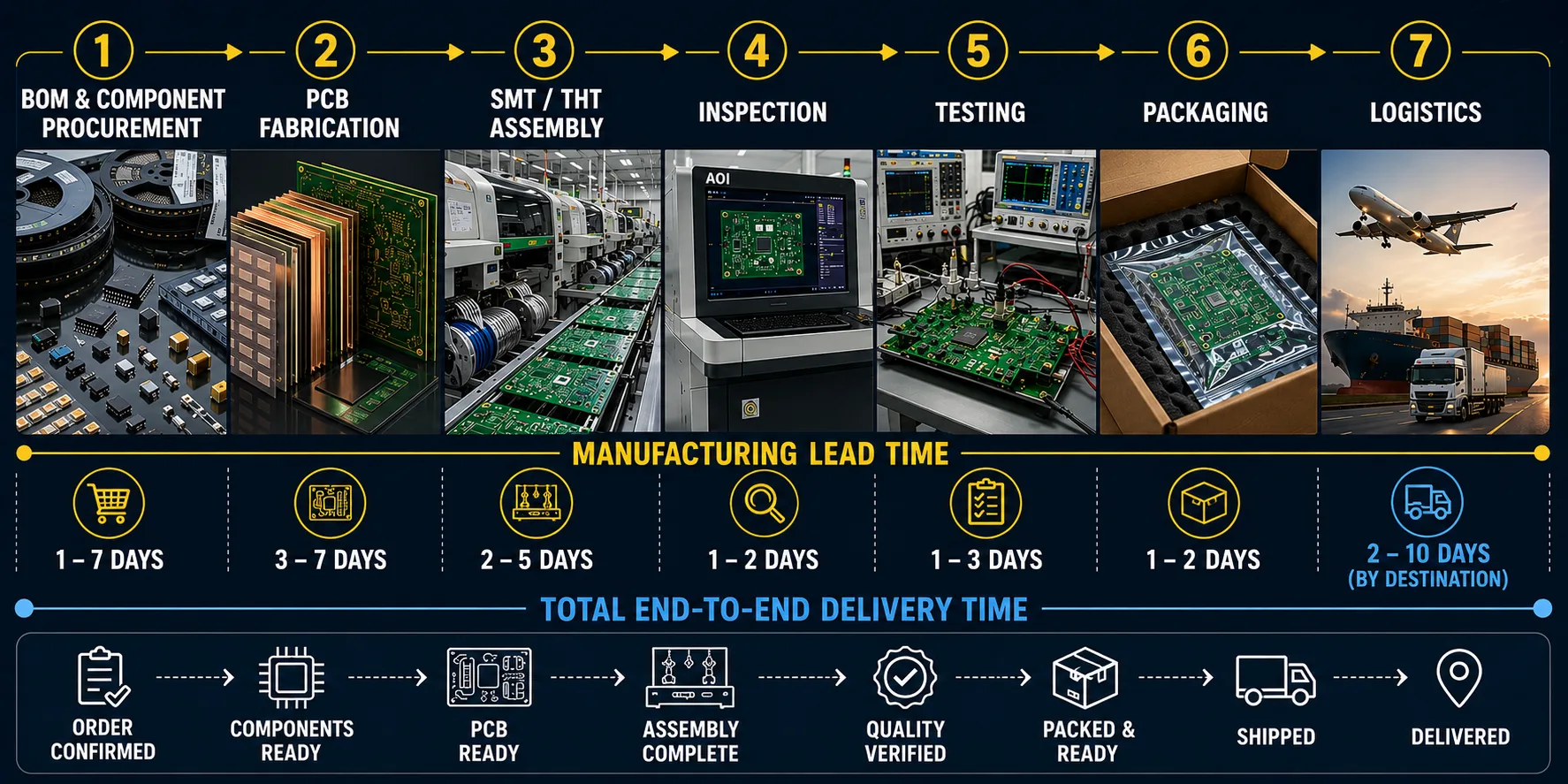

But the actual production cycle may involve:
→ BOM validation
→ Component procurement
→ PCB fabrication
→ Assembly
→ Testing
→ Packaging
→ Shipping
Therefore, clarify what the quoted lead time actually includes.
Also determine:
What happens when components are unavailable?
What is the normal production queue?
What is the expected logistics time?
Which activities can run in parallel?
This prevents unrealistic production planning.
A supplier transfer is already a period of change.
Avoid introducing unnecessary product changes at the same time.
If engineering changes are unavoidable, clearly distinguish:
Supplier-transfer changes
from
Product-design changes
This makes troubleshooting significantly easier.
Where possible, freeze the product baseline during the initial transfer and introduce subsequent changes through a controlled engineering-change process.
One of the simplest ways to create a transfer problem is to build the wrong revision.
Use controlled identification for:
PCB revision
BOM revision
Assembly revision
Firmware revision
Test-program revision
Manufacturing documentation revision
Every production release should clearly identify the approved versions.
Some products require supplier-specific tooling or fixtures.
These may include:
SMT stencils
Test fixtures
Programming fixtures
Assembly tooling
Inspection fixtures
Special packaging
Determine:
Who owns the tooling?
Can it be transferred?
Does it need to be recreated?
Has the new tooling been validated?
Are the test fixtures compatible?
A fixture that worked perfectly at one supplier may require adaptation for another manufacturing environment.
Packaging can affect product quality after manufacturing.
Consider:
ESD protection
Moisture sensitivity
Mechanical protection
Board separation
Labels
Serialization
Environmental conditions
International shipping requirements
The supplier transition is not complete until the finished product can move through the intended logistics chain without introducing new risks.
For critical products, consider maintaining the existing supplier until the new supplier has demonstrated production readiness.
This can provide a controlled fallback during the transition.
The exact strategy depends on:
Inventory
Cost
Product lifecycle
Supply requirements
Contractual obligations
Criticality of the product
The principle is simple:
Avoid creating a single point of failure during the supplier transition itself.

Do not release full production simply because the first pilot boards look acceptable.
Establish a formal release gate.
For example:
Documentation
Manufacturing package approved
Revision control established
BOM validated
Test documentation transferred
Engineering
DFM review completed
Critical manufacturing risks addressed
Tooling validated
Quality
Pilot inspection completed
Test results approved
Open critical issues closed
Supply Chain
Components available
Critical sourcing risks reviewed
Alternates approved where required
Production
Capacity confirmed
Lead time validated
Production process documented
Only after the relevant release criteria are met should full production begin.
For complex products, create a risk register.
A practical format is:
Risk | Probability | Impact | Mitigation | Owner | Status |
|---|---|---|---|---|---|
Component unavailable | — | — | Approved alternate | — | — |
DFM issue | — | — | Engineering review | — | — |
Test fixture incompatibility | — | — | Fixture validation | — | — |
Pilot yield issue | — | — | Process correction | — | — |
Capacity constraint | — | — | Capacity confirmation | — | — |
Documentation gap | — | — | Baseline review | — | — |
This makes risk visible and assigns responsibility.
Mistake 1: Selecting the new supplier solely on price
A low quotation does not guarantee low total cost.
Mistake 2: Assuming identical files guarantee identical results
Manufacturing processes differ between suppliers.
Mistake 3: Skipping the pilot
This transfers unresolved uncertainty directly into production.
Mistake 4: Allowing uncontrolled component substitutions
This can introduce electrical, mechanical or reliability risk.
Mistake 5: Forgetting test transfer
Manufacturing a board successfully does not prove that the product can be tested correctly.
Mistake 6: Transferring files without manufacturing knowledge
Critical process information can remain undocumented if the previous relationship depended on informal knowledge.
Mistake 7: Changing the product and supplier simultaneously
This makes root-cause analysis much harder.
Mistake 8: Assuming prototype success proves production readiness
A small pilot and sustained production are different manufacturing challenges.
Before Transfer
Reason for supplier change documented
Product baseline frozen
PCB data reviewed
Assembly data reviewed
BOM validated
Critical components identified
Test requirements documented
Existing manufacturing knowledge captured
New Supplier Qualification
Technical capabilities evaluated
DFM/DFA review completed
Quality processes reviewed
Component sourcing capability assessed
Testing capability confirmed
Production capacity evaluated
Lead time understood
Commercial scope normalized
Pilot Build
Pilot quantity defined
Tooling/stencils validated
PCB quality verified
Assembly quality verified
AOI/X-ray completed where applicable
Functional/electrical testing completed
Yield reviewed
Defects classified
Corrective actions closed
Production Release
Documentation approved
BOM approved
Components available
Test process validated
Capacity confirmed
Lead time validated
Traceability established
Open critical risks closed
Production release formally approved
A controlled supplier transfer can be thought of as five stages:
Stage 1 — Understand
Understand the existing product, manufacturing process and supplier dependencies.
Stage 2 — Prepare
Prepare the complete technical, quality, BOM and test package.
Stage 3 — Validate
Conduct DFM, BOM, process and supplier reviews.
Stage 4 — Prove
Run a pilot build and validate the results.
Stage 5 — Scale
Release production gradually and monitor early production performance.
This approach reduces the amount of uncertainty introduced at any one time.

Supplier qualification should not end when the first production order ships.
Monitor early production performance.
Potential indicators include:
First-pass yield
Defect rate
Rework
Test failures
Component shortages
Delivery performance
Corrective actions
Customer complaints
Production consistency
The initial production period provides valuable evidence about whether the new supplier is performing as expected.
Sometimes the objective is not to completely replace the existing supplier.
It may be to create a second source.
This can provide benefits such as:
Capacity diversification
Geographic diversification
Supply-chain resilience
Competitive benchmarking
Business continuity
However, dual sourcing also creates additional qualification and supply-chain-management requirements.
The appropriate strategy depends on the product, volumes, risk profile and commercial objectives.
A successful supplier transition should be structured around continuity and controlled validation.
For an international buyer, that means connecting the key elements of the manufacturing chain:
→ Engineering Review
→ PCB Manufacturing
→ BOM Validation
→ Component Sourcing
→ PCBA
→ Inspection & Testing
→ Pilot Build
→ Production
The goal is not simply to provide another factory.
The goal is to create a controlled manufacturing pathway in which technical requirements, sourcing decisions, quality expectations and production requirements remain visible throughout the transition.
For international buyers considering a PCB/PCBA supplier change, the most important question is not simply:
"Can the new supplier manufacture our board?"
It is:
"Can the new supplier reproduce the required product reliably while managing the engineering, component, quality, testing and production risks associated with the transition?"
QUADRIONIX approaches PCB/PCBA manufacturing with this broader perspective—connecting engineering, PCB fabrication, BOM and component sourcing, assembly, testing and production support into a coordinated manufacturing process.
Moving PCB/PCBA production to a new supplier does not have to be a high-risk event.
The greatest risk usually comes from treating the transfer as a simple procurement change.
A controlled transition instead:
Freezes the product baseline
Documents the complete manufacturing requirement
Validates the BOM and critical components
Performs a fresh DFM/DFA review
Transfers testing and manufacturing knowledge
Qualifies the new supplier
Runs a controlled pilot
Validates quality and functional performance
Confirms component availability and production capacity
Uses a formal production-release gate
Monitors early production
The central principle is simple:
Do not transfer uncertainty directly into production.
Identify it.
Validate it.
Control it.
Then scale.
A successful supplier change is therefore not simply about finding a manufacturer that can build the board.
It is about ensuring that the product, process, components, testing, quality and supply chain remain controlled throughout the transition.
Upload your Gerber files & BOM for automated DFM review, engineering feedback, and guaranteed delivery timelines.
