A Practical Engineering Guide to Reducing Component Risk, Improving Sourcing Flexibility, and Building More Resilient Electronics Supply Chains

A Bill of Materials is often treated as a simple list of components required to build a PCB assembly.
For engineering and procurement teams, however, the BOM is much more than that.
It defines the material inputs, specifications, sourcing constraints and commercial dependencies that ultimately determine whether a product can be manufactured repeatedly and economically.
A BOM can be technically correct and still create substantial manufacturing risk.
A component may be:
difficult to source,
approaching end-of-life,
available from only one manufacturer,
restricted to a single package,
subject to long lead times,
allocated during periods of constrained supply,
available only through a limited distribution channel,
or specified so tightly that technically acceptable alternatives cannot be introduced.
The result can be a familiar situation:
The PCB is ready. The factory is ready. The customer order is ready. But one component is preventing production.
Supply-chain stability therefore needs to be considered while the product is being engineered, not only when procurement begins.
A well-structured BOM should answer four questions:
What exactly do we need?
Can we source it reliably?
What happens if the preferred component becomes unavailable?
Can an alternative be introduced without compromising the product?
A BOM connects engineering decisions to manufacturing reality.
Consider two hypothetical designs.
Design A
A critical IC is available from:
One manufacturer
One package
One approved source
One qualified part number
The component is technically excellent.
But if that device becomes unavailable, the production line may stop.
Design B
The same functional requirement is defined with:
A preferred component
A qualified alternative
Clearly documented electrical requirements
Package compatibility
Defined approval criteria
Traceable sourcing information
Design B may have slightly more engineering work initially, but it has greater resilience.
This is the central principle:
The lowest-risk BOM is not necessarily the BOM with the cheapest individual components. It is the BOM that balances technical performance, availability, quality, lifecycle, sourcing flexibility and total manufacturing risk.
BOM risk usually comes from a combination of factors rather than one isolated problem.
The most common risk factors include:
Single-source dependency
Only one manufacturer or source can provide the required component.
Long lead time
The component requires significantly more time to procure than the rest of the BOM.
Lifecycle risk
The component is approaching:
Last-time-buy status
End-of-life
End-of-production
Manufacturer discontinuation
Limited distribution
The part is available through only a small number of authorized channels.
Highly specific requirements
The design specifies a component so narrowly that alternatives are difficult to qualify.
Package dependency
The electrical function may be widely available, but the selected package creates a sourcing constraint.
Regional availability
A component may be commercially available in one geography but difficult to procure in another.
Allocation
The manufacturer may restrict quantities during periods of supply constraint.
Counterfeit exposure
Components sourced through uncontrolled channels may introduce authenticity and traceability risks.
These factors should be assessed before the BOM becomes a production constraint.
One of the most common weaknesses in electronics BOMs is insufficient component information.
A production-ready BOM should contain enough information for engineering, procurement and manufacturing teams to understand exactly what is required.
Depending on the product and procurement model, useful fields can include:
BOM Field | Why It Matters |
|---|---|
Reference Designator | Identifies where the component is used |
Quantity | Defines build requirement |
Manufacturer | Identifies approved source |
Manufacturer Part Number | Defines exact component |
Description | Provides human-readable specification |
Package | Supports assembly planning |
Value / Rating | Defines electrical requirement |
Tolerance | Prevents unintended substitution |
Voltage / Current Rating | Defines operating requirement |
Temperature Rating | Important for application environment |
Lifecycle Status | Identifies obsolescence risk |
Preferred Supplier | Supports procurement |
Approved Alternate | Improves sourcing flexibility |
Datasheet | Provides technical reference |
Notes | Captures special requirements |
For more complex programs, additional fields may include:
Country of origin
Date-code requirements
Lot requirements
Compliance status
Moisture sensitivity level
Packaging requirements
Traceability requirements
Qualification status
Customer approval status
The objective is not to make the BOM unnecessarily complicated.
The objective is to make critical procurement and engineering information explicit.

This is one of the most important principles in BOM optimization.
Not every characteristic in a component selection has equal importance.
Consider a capacitor specified as:
10 µF, 25 V, X7R, ±10%, 0603
Some of these characteristics may be fundamental to circuit performance.
Others may simply represent the original designer's preferred component.
If the BOM does not distinguish between mandatory technical requirements and preferred characteristics, procurement may have no safe basis for proposing an alternative.

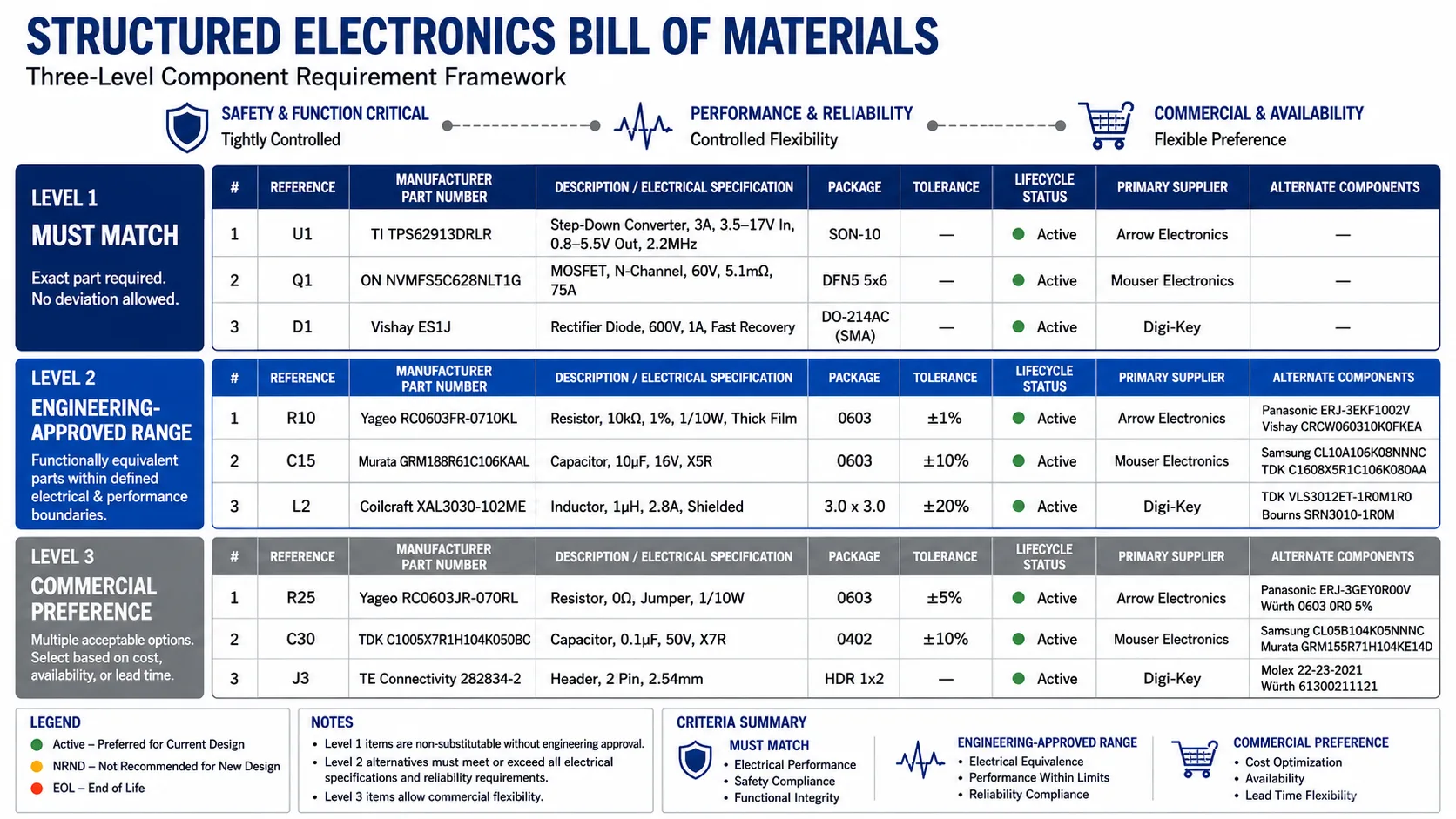

A better approach is to establish:
Must Match
Parameters that directly affect circuit performance, safety or compliance.
Examples:
Voltage rating
Capacitance
Tolerance
Temperature rating
Dielectric
Current rating
Package where mechanically/electrically necessary
Can Vary Within Limits
Parameters where engineering-defined alternatives may be acceptable.
Examples:
Manufacturer
Equivalent package family
Certain tolerance improvements
Certain ESR ranges
Certain dimensions within mechanical constraints
Commercial Preference
Characteristics that influence sourcing but do not necessarily define functionality.
Examples:
Preferred manufacturer
Preferred distributor
Preferred packaging quantity
This distinction makes alternate-component qualification substantially easier.
A resilient BOM should not automatically treat every component as having only one acceptable part number.
Where technically appropriate, consider establishing:
Preferred Part
The component normally purchased and used in production.
Approved Alternate
A component that has already been technically evaluated and accepted.
Potential Alternate
A candidate that may meet the requirement but still requires engineering qualification.
This distinction is important.
A component appearing on a distributor's website does not automatically qualify it as an engineering substitute.
An alternate must be evaluated against the requirements that matter to the product.
A component may appear equivalent based on its headline specification but still behave differently in the actual circuit.

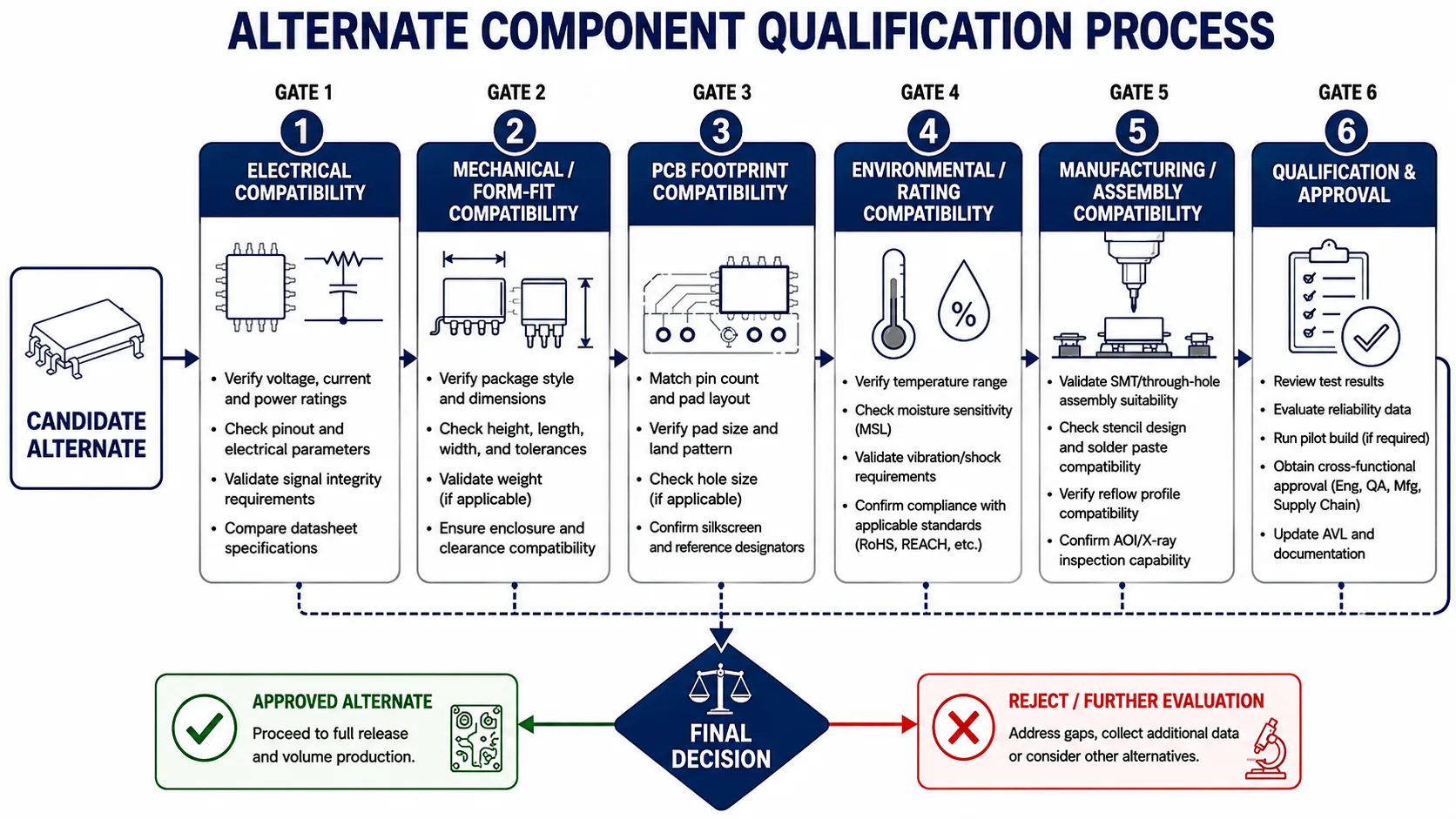

An alternate-component review may need to consider:
Electrical characteristics
Voltage
Current
Resistance
Capacitance
Inductance
Frequency response
ESR/impedance
Leakage
Power dissipation
Physical characteristics
Package
Dimensions
Pin configuration
Pad compatibility
Height
Weight
Mechanical clearance
Environmental characteristics
Operating temperature
Storage temperature
Humidity performance
Vibration requirements
Environmental qualification
Manufacturing characteristics
SMT/THT compatibility
Reflow capability
Moisture sensitivity
Packaging
Availability of suitable manufacturing data
Regulatory / compliance requirements
Depending on the application:
RoHS
REACH
Halogen requirements
Customer-specific compliance
Industry-specific requirements
The key principle is:
Form, fit and function must all be considered—not simply the component's headline electrical value.

A component substitution can create a PCB problem even when the electrical specifications appear acceptable.
For example:
A replacement IC may have the same electrical function but a different:
Package outline
Pin pitch
Pin assignment
Thermal pad
Height
Land pattern
Likewise, a capacitor or resistor with a different package size can affect:
PCB footprint
Assembly
Clearance
Rework
Mechanical interference

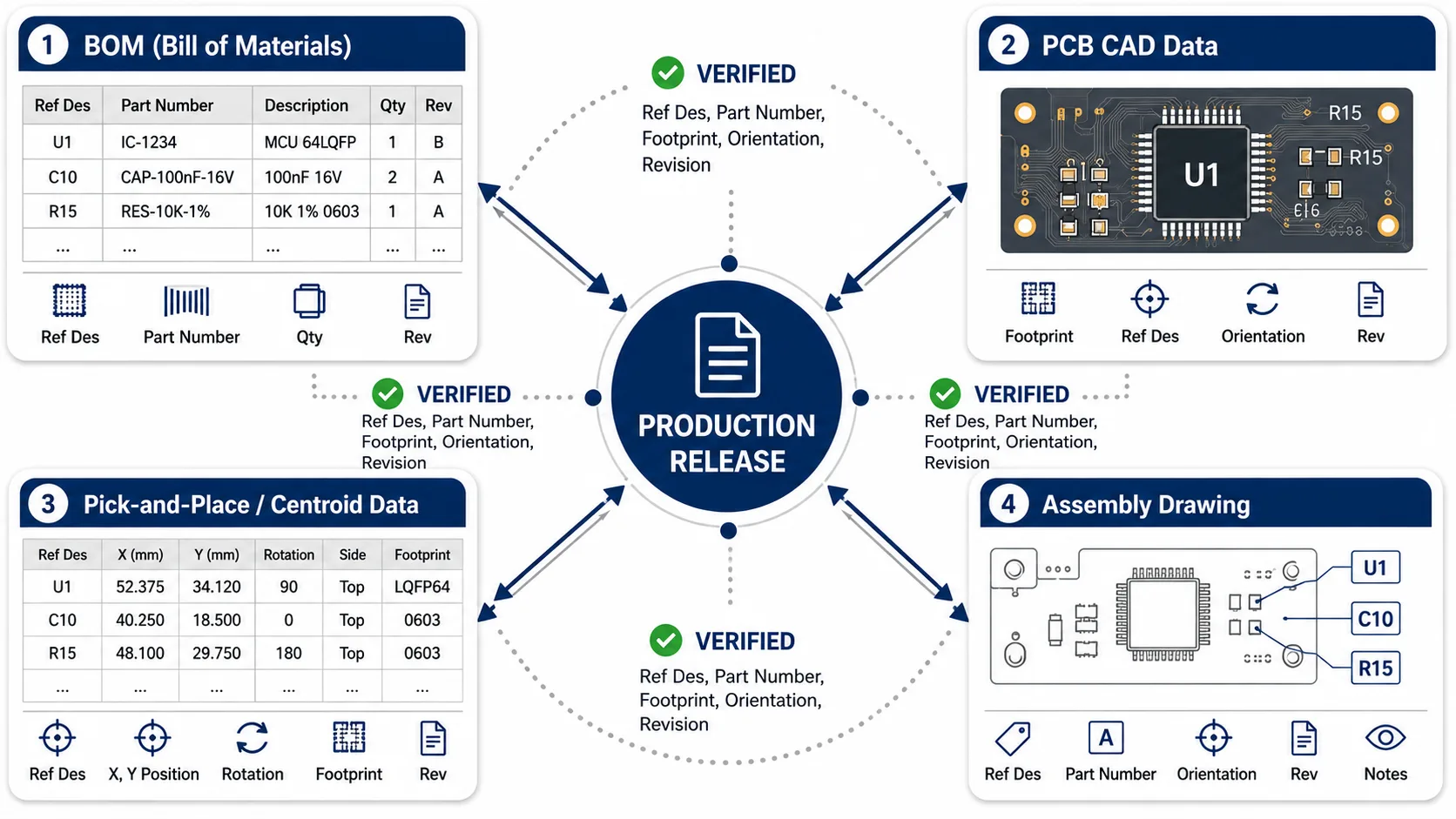

Therefore:
Component alternate review
must connect with
PCB footprint review
and
Assembly process review.
A component's current availability does not guarantee future availability.
A product designed today may remain in production for several years.
That creates a lifecycle mismatch:
Product Life
may be significantly longer than
Component Life.
A BOM review should therefore consider:
Current lifecycle status
Manufacturer longevity
Product-change notifications
Obsolescence notices
Availability history
Number of qualified sources
Expected production duration
This becomes particularly important for:
Industrial products
Medical equipment
Automotive electronics
Aerospace and defence
Infrastructure products
where products may remain in service for many years.
A distributor showing thousands of units in stock may provide short-term availability.
It does not necessarily prove long-term supply stability.
Ask:
Who manufactures the component?
Is the manufacturer still producing it?
Is the part active?
Is there more than one authorized source?
Is the inventory from an authorized channel?
What is the normal lead time?
Is the current stock exceptional or normal?
What happens when that inventory is exhausted?
This distinction matters when planning production rather than simply purchasing components for one prototype.

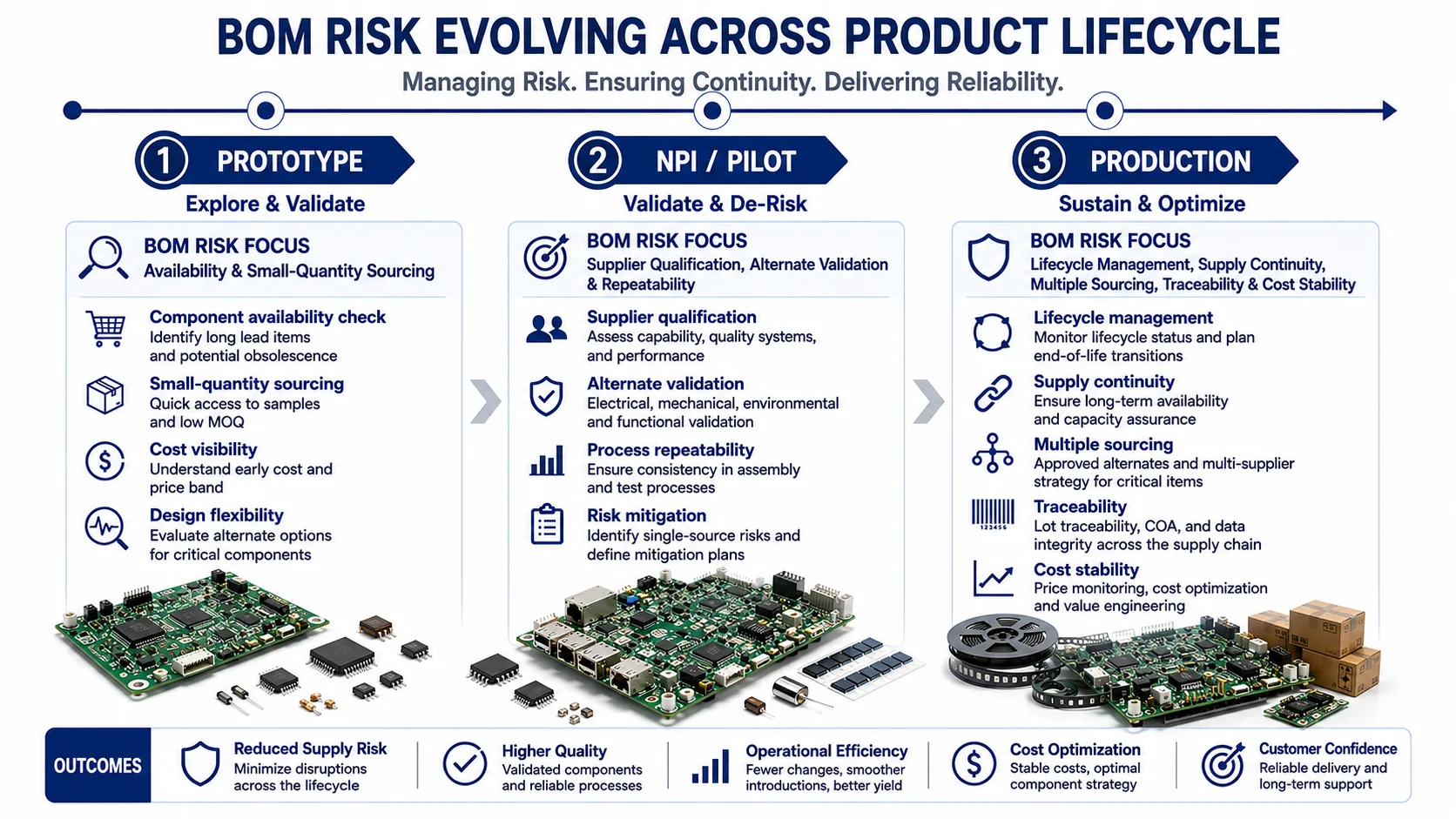

BOM risk changes throughout the product lifecycle.
Stage 1 - Prototype
Primary concern:
Can we obtain enough components to build and validate the design?
Stage 2 - NPI / Pilot
Primary concerns:
Repeatability
Supplier qualification
Lead time
Component availability
Alternate qualification
Manufacturing readiness
Stage 3 - Production
Primary concerns:
Long-term supply
Cost stability
Lifecycle
Multiple sourcing
Traceability
Change management
A component that is acceptable for a prototype may be inappropriate for a five-year production program.
Not every BOM line deserves the same level of supply-chain attention.
A practical approach is to classify components according to risk.
Low Risk
Multiple manufacturers and distributors are available.
Examples may include common:
Resistors
Capacitors
Standard connectors
Common discrete components
Medium Risk
Some sourcing constraints exist.
Examples:
Specialized connectors
Specific package variants
Higher-performance components
High Risk
Limited sources, long lead time, lifecycle concerns or significant qualification requirements.
Examples can include:
Specialized processors
FPGAs
Certain power devices
Custom components
Specialized sensors
Long-lead connectors
The exact risk classification should depend on the product and application.
Risk Factor | Low Risk | Medium Risk | High Risk |
|---|---|---|---|
Qualified sources | Multiple | Limited | Single |
Lead time | Short/stable | Variable | Long/uncertain |
Lifecycle | Active | Watch | EOL/at risk |
Alternate | Qualified | Candidate | None |
Distribution | Broad | Limited | Restricted |
Technical substitution | Easy | Requires review | Difficult |
Production impact | Low | Moderate | Potential line stop |
A high-risk component does not necessarily mean it should be removed.
It means the component requires more deliberate risk management.
Engineers understandably want to control product performance.
But over-specification can unintentionally reduce sourcing flexibility.
For example, specifying a component by:
Exact manufacturer
Exact part number
Exact package
Exact tolerance
Exact electrical characteristics
may eliminate components that are technically suitable.
Where appropriate, specifications can instead define:
Required performance → acceptable range → qualification requirements
rather than:
One exact commercial part number
This should never be done blindly.
For safety-critical, regulated or performance-sensitive applications, the exact component may genuinely be part of the design requirement.
The objective is controlled flexibility, not indiscriminate substitution.
An Approved Vendor List can improve control, but it can also become a supply-chain constraint if it is too narrow.
A useful AVL should distinguish between:
Approved manufacturer
Approved part
Approved distributor
Qualified alternate
Qualification status
For critical components, consider whether there is sufficient sourcing diversity.
A BOM that says:
Manufacturer: X only
may represent a substantially different risk profile from:
Manufacturer: X preferred; Y qualified alternate
provided both components genuinely satisfy the engineering requirements.

Supply resilience is not only about availability.
It is also about knowing what was actually purchased and installed.
For higher-risk products, traceability may include:
Manufacturer
Part number
Lot
Date code
Supplier
Purchase order
Production lot
Assembly serial number
IPC-1782 addresses manufacturing and supply-chain traceability and uses a risk-based approach to determine appropriate traceability levels. The standard covers materials and processes and includes concepts such as material traceability and production records.
The appropriate level of traceability should be agreed according to product risk and customer requirements rather than applied identically to every product.
A BOM can be technically correct and still create manufacturing risk if revision control is weak.
The manufacturing team must know:
Which BOM revision is current?
And procurement must know:
Which component version is approved for that revision?
Changes should therefore be controlled.
Typical BOM changes may include:
Component substitution
Manufacturer change
Package change
Value change
Lifecycle replacement
Approved alternate addition
Supplier change
Each change should have an appropriate approval mechanism.
For many products, the engineering change process should connect:
Engineering → Procurement → Quality → Manufacturing
rather than allowing procurement substitutions to occur independently.

A resilient BOM is not useful if it does not match the rest of the manufacturing dataset.
At minimum, review consistency between:
BOM
What components are required?
PCB Design
Where are they used?
Pick-and-Place Data
Where should the machine place them?
Assembly Drawing
How should they be oriented and assembled?
Manufacturing Data
What revision of the PCB is being manufactured?
A mismatch can create:
Missing components
Incorrect component placement
Wrong component values
Orientation errors
Procurement errors
Production delays
This is why BOM validation should happen before production release.
This distinction is particularly important in global sourcing.
Suppose Component A costs:
$1.00
and Component B costs:
$0.92
Component B appears cheaper.
But if B has:
Longer lead time
Higher MOQ
Limited availability
Higher freight
Greater quality risk
No qualified alternate
then the $0.08 saving may be irrelevant.
A better evaluation considers total landed and operational cost.
Potential cost elements include:
Unit price
MOQ
Freight
Duties/taxes where applicable
Inventory carrying cost
Qualification cost
Expediting
Rework
Scrap
Production downtime
Obsolescence exposure
This is why procurement decisions should not be based exclusively on the lowest quoted unit price.

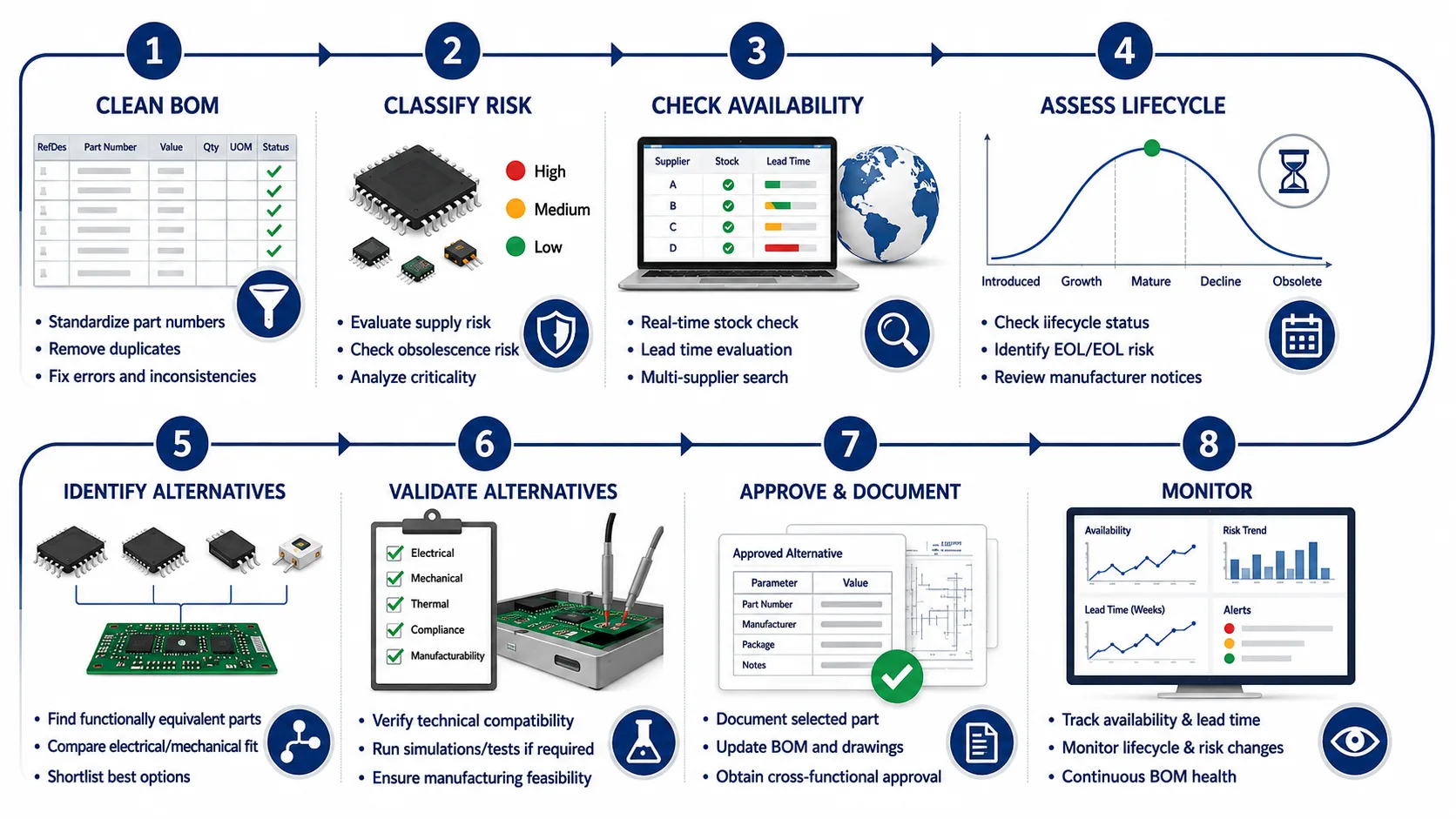

A disciplined workflow can be relatively straightforward.
Step 1 - Clean the BOM
Remove:
Duplicate entries
Ambiguous descriptions
Missing manufacturer information
Incorrect part numbers
Inconsistent package descriptions
Step 2 - Classify Components
Separate:
Standard components
Specialized components
High-risk components
Single-source components
Step 3 - Check Availability
Review:
Current availability
Lead time
Distributor coverage
Manufacturer status
Step 4 - Assess Lifecycle
Identify:
Active
Not recommended for new designs
EOL risk
Obsolete
Step 5 - Identify Alternatives
Determine where qualified or candidate alternatives are practical.
Step 6 - Validate Alternatives
Check:
Electrical → Mechanical → Environmental → Manufacturing → Compliance
Step 7 - Document Approval
Record which alternates are:
Approved
Pending qualification
Not acceptable
Step 8 - Monitor
Supply-chain risk is dynamic.
A BOM should be reviewed periodically, particularly for long-lived products.
Before releasing a BOM for production, ask:
Component Identity
☐ Manufacturer part number verified☐ Description matches part number☐ Package verified☐ Datasheet available
Technical Requirements
☐ Electrical ratings verified☐ Tolerance verified☐ Temperature requirements verified☐ Mechanical requirements verified☐ Compliance requirements verified
Supply Risk
☐ Availability checked☐ Lead time checked☐ Lifecycle status checked☐ Single-source components identified☐ High-risk components identified
Alternatives
☐ Approved alternatives identified where appropriate☐ Alternate electrical parameters checked☐ Footprint compatibility checked☐ Mechanical compatibility checked☐ Manufacturing compatibility checked☐ Qualification status documented
Manufacturing Data
☐ BOM matches PCB revision☐ BOM matches pick-and-place data☐ Reference designators consistent☐ Assembly documentation consistent☐ Revision control verified
A good sourcing discussion should go beyond:
"What is your price?"
Ask:
Can you provide manufacturer traceability?
Especially for higher-risk components.
Is the component sourced through an authorized channel?
Where authenticity and traceability are important.
What is the current lead time?
And is the quoted lead time based on actual availability or manufacturer lead time?
Is the part active?
Don't assume current stock means long-term availability.
Are there qualified alternatives?
If yes:
Are they already approved, or do they require engineering qualification?
What is the MOQ?
A low unit price may become unattractive if MOQ creates excessive inventory.
Can the supplier support the expected production period?
A prototype supplier and a long-term production supplier may not necessarily be the same.
The $0.08 Component That Stopped Production
Consider a controller PCB using a specialized power-management IC.
The original BOM specifies a preferred manufacturer and part number.
During the prototype stage, the component is readily available.
Six months later, production planning begins.
The part is still technically active, but available inventory has become constrained and lead time has increased significantly.
The rest of the BOM is available.
The PCB fabrication capacity is available.
The assembly capacity is available.
Yet production cannot proceed because one critical component is missing.
What could have been done earlier?
During the NPI stage, the engineering team could have identified the component as:
High supply risk → single source → long-term production dependency
and initiated alternate qualification.
The objective would not have been to replace the preferred component unnecessarily.
It would have been to establish a validated second option before the shortage occurred.
That is the difference between:
reactive sourcing
and
supply-chain engineering.
For customers outsourcing PCB manufacturing and assembly, BOM management is closely connected to the manufacturing workflow.
A practical engagement can include:
→ BOM Review
→ Component Availability Assessment
→ Supply-Risk Identification
→ Alternate Identification
→ Technical Compatibility Review
→ Procurement Planning
→ PCB Fabrication
→ PCB Assembly
→ Inspection & Validation
The exact scope depends on the customer's requirements and the level of sourcing responsibility assigned to the manufacturing partner.
The goal is straightforward:
Identify component-related manufacturing risks before they become production delays.
Before releasing a BOM for production, confirm:
1. Every component is clearly identified.
2. Critical technical requirements are explicit.
3. High-risk components have been identified.
4. Lifecycle status has been considered.
5. Single-source dependencies are visible.
6. Qualified alternatives exist where practical.
7. Alternatives have been technically evaluated rather than assumed equivalent.
8. BOM, PCB and manufacturing data are synchronized.
9. Traceability requirements are defined according to product risk.
10. Revision control is established.
11. Procurement decisions consider total supply-chain risk—not only unit price.
12. The BOM is reviewed again as the product moves from prototype to production.
A Bill of Materials is not simply a purchasing document.
It is one of the most important connections between engineering design, manufacturing execution and supply-chain resilience.
A robust BOM makes critical requirements explicit, identifies supply dependencies, creates controlled sourcing flexibility and provides the information needed for procurement and manufacturing teams to make informed decisions.
The strongest approach is therefore not:
Choose a component → buy it → build the product.
It is:
Define the requirement → assess supply risk → identify options → qualify alternatives → control the BOM → monitor the supply chain.
For electronics products intended for sustained production, this approach can reduce the likelihood that a single unavailable component becomes a manufacturing bottleneck.
Ultimately, BOM optimization is not about having more part numbers or more alternate components. It is about having the right technical controls and the right sourcing options for the components that matter most.
That is what turns a BOM from a static parts list into a manufacturing and supply-chain risk management tool.
