A practical framework for evaluating technical capability, turnkey scope, BOM sourcing, quality, testing, NPI, scalability, supply-chain resilience, delivery and total manufacturing risk

How to Evaluate a PCB/PCBA Manufacturing Supplier: The Complete Buyer’s Guide
Selecting a PCB/PCBA manufacturing supplier is not simply a procurement exercise.
For a simple prototype, the process may appear straightforward:
Send the files → receive a quotation → select a manufacturer → build the boards.

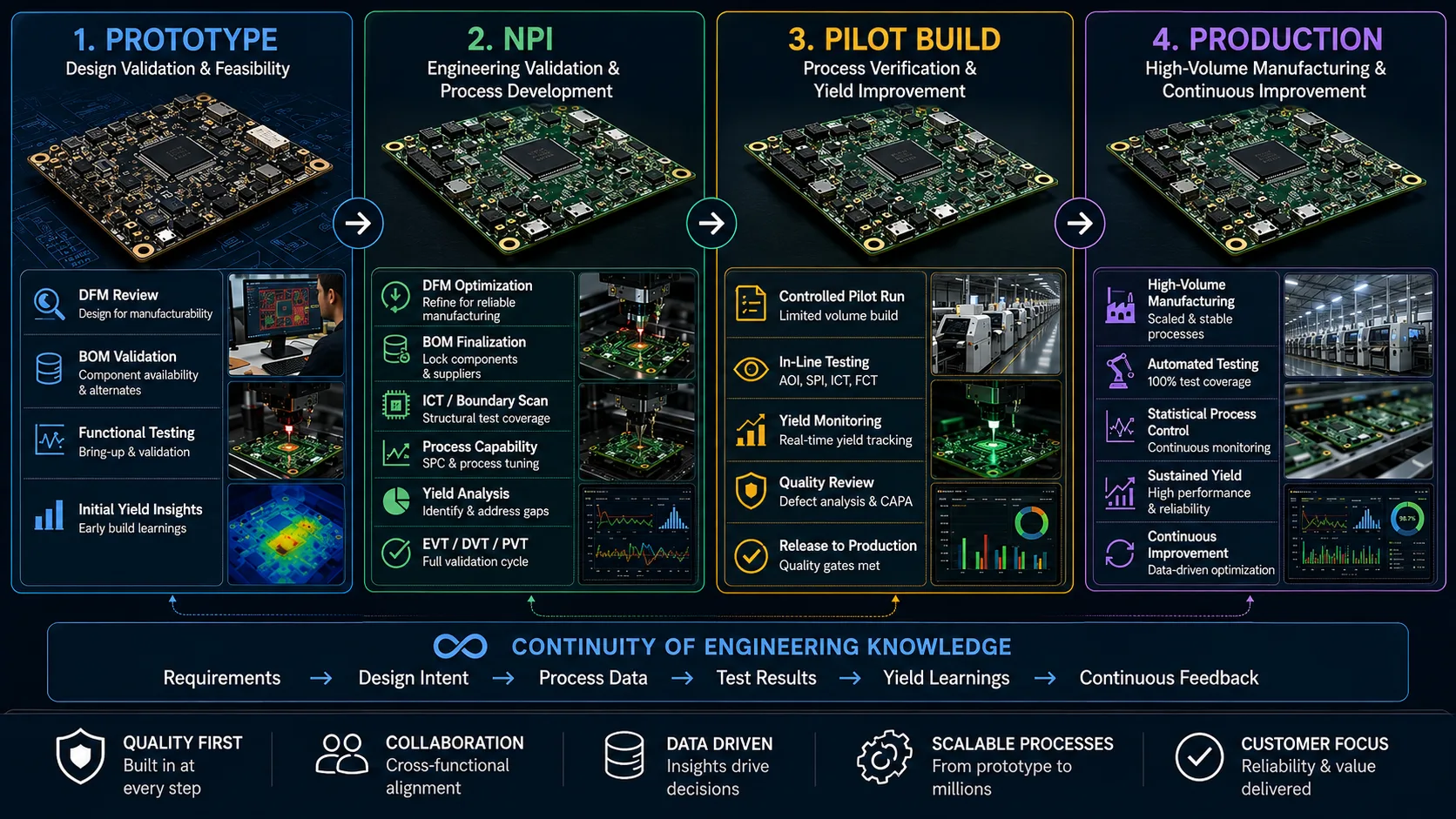

But as an electronic product moves toward NPI, pilot production and recurring manufacturing, the supplier becomes part of the product's manufacturing system.
The supplier may influence:
PCB manufacturability
BOM availability
component sourcing
assembly quality
testing
production yield
lead time
engineering changes
supply-chain continuity
NPI execution
production scalability
total manufacturing cost.
For turnkey PCBA, the responsibility can extend even further—from PCB procurement and component sourcing through assembly, inspection, testing, programming, packaging and delivery.
That makes the real question not:
“Who can manufacture this PCB at the lowest price?”
but:
“Which manufacturing partner can reliably build this product to specification, at the required quality and volume, while managing technical, supply-chain and commercial risk?”
This guide provides a structured way to answer that question.

Supplier capability should be evaluated against the actual technical requirements and risks of the product—not against a generic capability list.
One of the most common supplier-selection mistakes is evaluating manufacturers before clearly defining the manufacturing requirement.
The right supplier depends on the product.
A simple two-layer control board and a high-density multilayer industrial controller may require completely different capabilities.
Before evaluating suppliers, document the actual manufacturing requirements.
PCB Requirements
Consider:
Layer count
Board dimensions
Board thickness
Copper weight
Material
Surface finish
Minimum trace/space
Via technology
Controlled impedance
HDI requirements
Blind/buried vias
Microvias
Special fabrication requirements
Reliability requirements
Electrical testing requirements
Assembly Requirements
Consider:
SMT
THT
Mixed technology
BGA
Fine-pitch components
Bottom-side assembly
Double-sided assembly
Reflow
Selective soldering
Wave soldering where applicable
Cleaning
Programming
Conformal coating where required
Component Requirements
Consider:
BOM size
Component availability
Approved manufacturers
Lifecycle constraints
Critical components
Alternate-component policy
Long-lead components
Obsolescence risk
Testing Requirements
Consider:
SPI
AOI
X-ray
ICT
Flying probe
Functional testing
Programming/firmware loading
Boundary scan where applicable
Custom test fixtures
Production Requirements
Define:
Prototype quantity
NPI quantity
Pilot quantity
Annual volume
Expected production ramp
Delivery requirements.
Only after these requirements are defined can supplier capability be evaluated properly.

A turnkey PCBA relationship can cover the manufacturing chain from PCB procurement and component sourcing through assembly, testing and delivery. Confirm the exact scope with every supplier.
This becomes especially important when evaluating turnkey PCBA suppliers.
“Turnkey PCBA” does not necessarily mean exactly the same thing from one supplier to another.

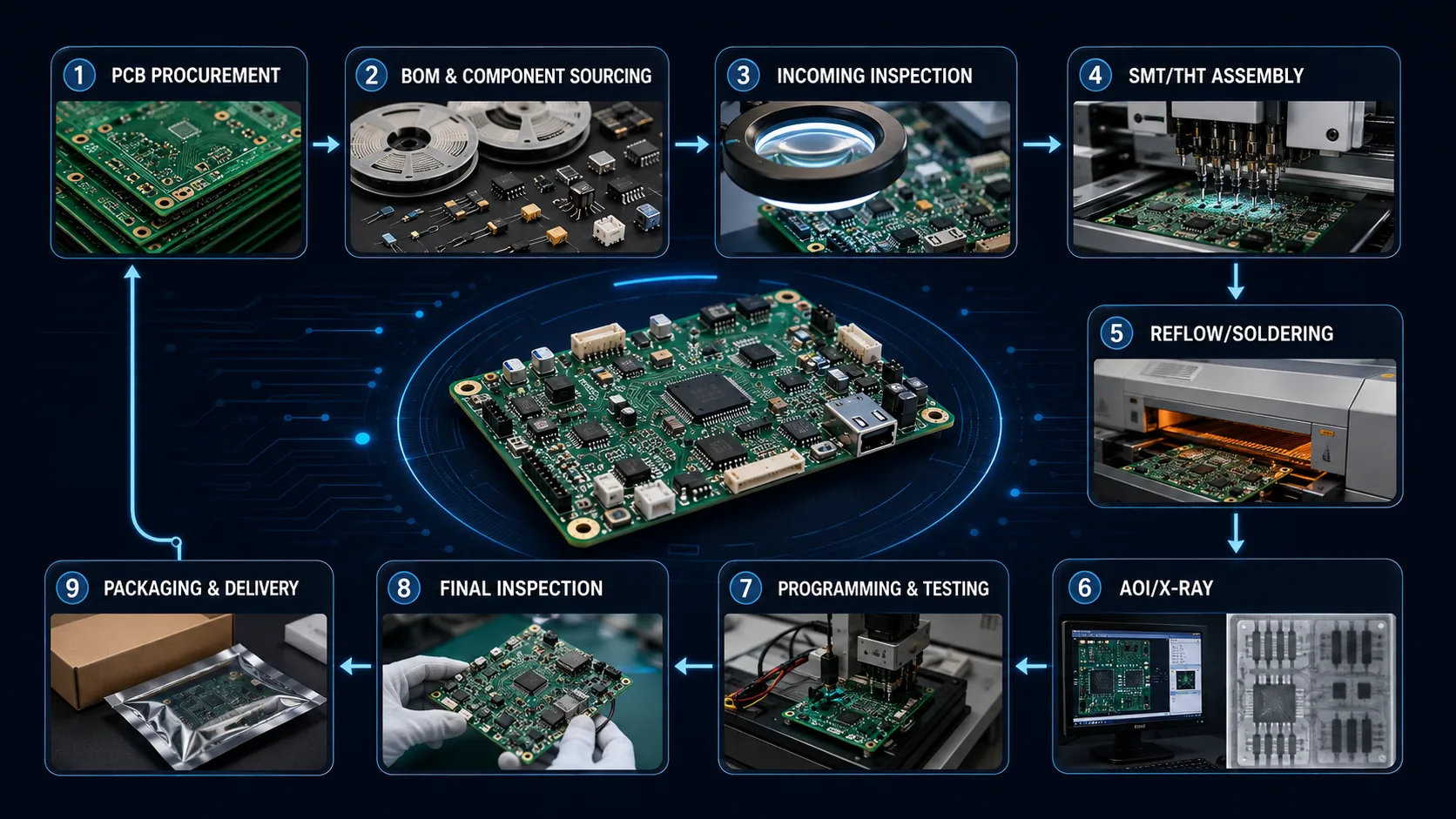

A typical turnkey arrangement may include:
→ PCB procurement
→ BOM management
→ Component sourcing
→ Incoming inspection
→ SMT/THT assembly
→ Reflow/soldering
→ AOI/X-ray
→ Programming
→ Testing
→ Final inspection
→ Packaging
→ Delivery
But buyers should never assume that every supplier includes the same scope.
Ask:
“Please define everything included in your turnkey PCBA service.”
Clarify whether the quotation includes:
Bare PCB manufacturing
Component procurement
Component receiving
Incoming inspection
SMT
THT
Reflow
Selective/wave soldering
AOI
X-ray
Programming
Functional testing
Final inspection
Cleaning
Conformal coating
Labeling
Packaging
Logistics.
A supplier may call itself “turnkey” while subcontracting or excluding important operations.
The objective is therefore to establish the actual manufacturing responsibility matrix in writing.
A supplier may advertise broad PCB/PCBA capabilities.
That does not automatically mean it is the right supplier for your product.
The critical question is:
Can the supplier reliably manufacture my specific design?
For example, if your PCB uses:
BGA
controlled impedance
fine-pitch components
HDI
microvias
evaluate those capabilities specifically.
Look at:
Minimum trace/space
Layer-count capability
HDI
Microvias
Via-in-pad
Controlled impedance
Fine-pitch SMT
BGA assembly
THT
Mixed technology
Thermal requirements
Special materials
Complex testing.
This is one of the most important distinctions in supplier evaluation.
A supplier may own sophisticated equipment.
But equipment alone does not guarantee manufacturing performance.
For example, owning an advanced SMT placement machine does not automatically demonstrate competence in:
Process engineering
Stencil optimization
Thermal-profile development
BGA process control
Defect prevention
Inspection
Rework
Yield improvement.
Instead of asking only:
“What machines do you have?”
also ask:
“What process controls do you use to consistently produce the required result?”
The second question reveals considerably more about manufacturing maturity.
Depending on the product, assess:
Multilayer fabrication
High-Tg materials
Heavy copper
Controlled impedance
HDI
Blind/buried vias
Microvias
Surface finishes
Tight dimensional tolerances
Electrical testing
Reliability testing where required.
Ask the supplier to explain how its manufacturing process accommodates the critical characteristics of your PCB, rather than simply asking whether the capability exists.
For assembly, assess:
SMT placement
THT assembly
BGA assembly
Fine-pitch placement
Component package range
Double-sided assembly
Reflow
Selective soldering
Wave soldering where applicable
Cleaning
Inspection
Rework.
The key question is not:
“Can you assemble a board?”
It is:
“Can you establish a repeatable production process for our board?”
Quality should not be reduced to:
“Do you have ISO certification?”
Certifications can be useful indicators of organizational discipline, but supplier evaluation should go further.
Ask how quality is controlled throughout the manufacturing process.
Incoming
Component inspection
Material verification
Documentation
Traceability
PCB Fabrication
Process controls
Electrical testing
Dimensional checks
Surface-finish controls
Assembly
Solder-paste inspection
Placement verification
Reflow control
AOI
X-ray where appropriate
Final
Functional testing
Visual inspection
Electrical testing
Documentation
Traceability.
A strong supplier should be able to explain not only where defects are detected, but how they are prevented.
Every manufacturing process can experience defects.
What differentiates suppliers is often how they respond.
Ask:
How are defects recorded?
How is root cause determined?
Who owns corrective action?
How is recurrence prevented?
How are customer complaints handled?
Is formal corrective-action documentation available?
A supplier's response to a problem can reveal as much about its manufacturing maturity as its normal production process.
A mature process should connect:
→ Detection
→ Root Cause
→ Corrective Action
→ Verification
→ Prevention.
Do not simply ask:
“Do you provide testing?”
Ask:
“Which defects can your current inspection and testing process detect?”
Potential methods include:
SPI
AOI
X-ray
Visual inspection
Microscopy
Electrical testing
ICT
Flying probe
Functional testing
Programming
Boundary scan where applicable
Automated functional testing
Custom test fixtures.
Different methods identify different categories of problems.
The correct inspection and test strategy should therefore be matched to the product.
For assemblies containing BGA or other hidden solder joints, ask:
Is X-ray available?
What type of X-ray inspection is used?
How are BGA defects analyzed?
How is rework handled?
How are voiding and solder-joint quality evaluated?
The appropriate inspection method depends on the package, process and product requirements.
Testing capability is not just about owning a tester.
Ask:
Can the supplier help define the test strategy?
Who develops the test fixture?
Who pays for it?
Who owns it?
Who maintains it?
How are revisions handled?
How is test software controlled?
What happens when the PCB design changes?
For dedicated testing, fixture ownership and revision control should be defined before production begins.
For turnkey PCBA, component sourcing can become one of the supplier's most important responsibilities.
Evaluate whether the supplier can manage:
BOM validation
Manufacturer Part Number verification
Component availability
Lifecycle status
Lead times
Approved alternates
Obsolescence
Allocation
Supply continuity
Minimum order quantities
Packaging
Long-lead components.
A supplier that can manufacture the board but cannot reliably manage its component supply chain may not be suitable for long-term production.
Ask:
“Will you manage component sourcing and BOM procurement, and who is responsible for BOM validation?”
A supplier should be able to explain how it handles:
Manufacturer Part Numbers
Approved manufacturers
Component availability
Lead times
Lifecycle
MOQ
Packaging
Alternates
Obsolete components
Long-lead components.
The cheapest available component should not automatically become the selected component.
A good BOM review should go beyond checking whether a part number exists.
Ask whether the supplier checks:
Part Number Accuracy
Is the MPN valid and correctly specified?
Availability
Can the component be sourced reliably?
Lifecycle
Is it active, NRND or obsolete?
Package
Does the physical package match the PCB?
Quantity
Are sufficient quantities available?
Alternate Sources
Are technically suitable alternatives available?
Lead Time
Could any component constrain production?
For turnkey PCBA, component sourcing is a major supplier-qualification issue.
Ask:
Which authorized distributors do you use?
How do you handle franchised vs independent sourcing?
How do you assess supplier risk?
How do you manage counterfeit risk?
What incoming inspection is performed?
Can you provide traceability?
How do you handle difficult-to-source components?
You do not necessarily need every component to come from a single distributor.
You do need to understand how sourcing risk is controlled.
Ask:
“What happens if one of our approved components becomes unavailable?”
A controlled process should look approximately like:
Component Shortage
↓
Alternate Identified
↓
Technical Comparison
↓
Engineering Review
↓
Customer Approval
↓
BOM/Document Revision
↓
Controlled Production
An unapproved substitute should not enter production merely because it is available.
Depending on product requirements, determine whether the supplier can maintain:
Manufacturer
Manufacturer Part Number
Lot/batch
Date code
Source
Purchasing documentation
Certificates where applicable.
For finished assemblies, traceability may also include:
Component lots
PCB lots
Production batches
Test results
Assembly date
Firmware/software revision
Rework
Inspection results.
The required depth should match the product, industry and applicable requirements.

A capable manufacturing partner should identify manufacturability and testability risks before production begins.
A manufacturing supplier should ideally contribute engineering value before production.
Ask whether the supplier reviews:
DFM
PCB manufacturability
Component spacing
Pad design
Fiducials
PCB edge clearance
Thermal pads
Fine-pitch components
BGA considerations
Panelization
Assembly orientation
DFT
Test-point accessibility
ICT feasibility
Flying probe
Functional testing
Programming
Fixture requirements.
A good DFM/DFT process should identify potential production problems before they become production problems.
This is one of the best ways to understand actual supplier maturity.
Ask:
“Can you walk me through what happens from the moment you receive our Gerbers and BOM until the first production-ready PCBA is shipped?”
A structured answer may include:
→ Data Review
→ BOM Validation
→ DFM/DFT
→ Quotation
→ Procurement
→ PCB Fabrication
→ Assembly
→ Inspection
→ Testing
→ Pilot/NPI
→ Quality Release
→ Production
→ Shipment.
This question effectively reveals whether the supplier sees manufacturing as an integrated process or merely as an assembly transaction.
Prototype manufacturing and production manufacturing are not identical.
During NPI, the supplier may need to support:
Design review
DFM
DFT
BOM validation
Process development
Stencil development
Assembly setup
Reflow-profile development
Inspection strategy
Functional test development
First-article evaluation
Yield analysis
Corrective action
Engineering changes
Production release.
Ask:
“What happens between receiving our design files and releasing the first production-ready process?”
The answer can reveal actual NPI maturity.

A strong manufacturing partner can maintain continuity as a product moves from prototype through production.
Ask:
“Can you support us from prototype through NPI and production?”
Then ask:
What minimum quantity can you support?
What happens as volume increases?
Does the same engineering team remain involved?
Can production move to another line if necessary?
How is process knowledge transferred?
The goal is to avoid unnecessary supplier transitions as the product matures.
A supplier may be excellent for prototypes but unsuitable for production ramp.
Evaluate:
Prototype → NPI → Pilot → Production → Ramp
Ask about:
Current capacity
Capacity allocated to your product
Production scheduling
Equipment capacity
Labor requirements
Component procurement
Production planning
Capacity expansion
Quality maintenance during ramp
Additional shifts
Additional lines.
The objective is to avoid selecting a supplier that becomes a bottleneck as demand increases.
Do not ask only:
“What is your factory capacity?”
Ask:
“What capacity can realistically be allocated to our product at our expected production volumes?”
Then ask:
What are current utilization levels?
What volumes can you support?
How quickly can capacity increase?
How do you handle production peaks?
What happens if demand doubles?
A headline factory-capacity number is far less useful than capacity that can actually be committed to your program.
Do not evaluate lead time based only on PCB fabrication.
Total PCBA lead time can include:
Engineering Review
→ Component Sourcing
→ PCB Fabrication
→ Assembly
→ Testing
→ Packaging
→ International Shipping
Ask:
“What assumptions is this lead time based on?”
Component availability can have a major effect on the final schedule.
Also ask for separate estimates for:
Quotation
DFM review
PCB fabrication
Component procurement
Assembly
Testing
Final inspection
Shipment.
A supplier's manufacturing capability is only one part of production continuity.
Evaluate how it handles:
Component shortages
Obsolescence
Allocation
Single-source components
Alternate sourcing
Supplier disruption
Long-lead components
Difficult-to-source parts.
A structured supply-chain risk-management approach can reduce production interruptions.
Ask:
“If a critical component is delayed, what options will you present to us?”
Possible responses may include:
Alternate sourcing
Partial production
Inventory reservation
Schedule adjustment
Customer-approved alternate
Split shipment.
The important point is that the supplier should communicate the risk early.
For international production, consider:
Shipping routes
Transit time
Customs
Import requirements
Freight options
Communication time zones
Documentation
Local support requirements.
The objective is not simply to choose the geographically closest supplier.
It is to determine whether the supplier's location and logistics model work effectively for your supply chain.
This is particularly important if the supplier uses qualified manufacturing partners.
Ask:
Which processes are performed directly?
Which are subcontracted?
Who controls quality?
Who controls scheduling?
Who handles customer communication?
Who is responsible for non-conformances?
External manufacturing partners are not inherently problematic.
The critical issue is:
Who owns the final manufacturing outcome?
Ask how the supplier handles:
Minimum order quantities
Reel quantities
Component excess
Production scrap
Customer-owned inventory
Unused components after a production run.
These factors can materially affect total manufacturing cost.
Define ownership of:
Customer-owned inventory
Supplier-owned inventory
Work-in-progress
Finished goods
Excess components.
Documenting ownership in advance helps prevent disputes later.
A supplier quotation should clearly identify:
PCB cost
Component cost
Assembly cost
Testing
Programming
Tooling
NRE
Packaging
Freight
Taxes/duties where applicable
Engineering/NPI charges
Payment terms
Quote validity
Lead time
Assumptions
Exclusions.
The objective is not necessarily to force every supplier into an identical pricing format.
It is to understand what the quoted price actually represents.
Projects may require:
Stencils
Fixtures
Test fixtures
Programming fixtures
Engineering setup
Special tooling.
Ask:
“Which non-recurring engineering or tooling costs apply, and who owns the resulting tooling?”
This prevents unexpected costs later.
Ask separately about:
Prototype MOQ
NPI/pilot MOQ
Production MOQ
Component purchasing MOQ
PCB fabrication MOQ.
A supplier may accept a small assembly order while certain components still require larger procurement quantities.

The lowest quotation is not necessarily the lowest sustainable manufacturing cost.
Price matters.
But it should be evaluated after understanding:
Scope + Quality + Engineering + Supply Chain + Testing + Delivery + Risk
A lower assembly price may still produce higher total costs through:
Poor yield
Higher rework
Component shortages
Longer lead times
Engineering changes
Logistics problems
Production delays.
The objective is:
Lowest sustainable total cost at the required quality and delivery performance.
Communication during the RFQ stage can be an early indicator of how the supplier may operate later.
Observe:
Response time
Technical understanding
RFQ clarification
Documentation quality
Willingness to identify risks
Ability to answer engineering questions.
A supplier that simply returns a price without understanding the design may create problems later.
A strong supplier may ask:
Is the impedance requirement specified?
Is this component manufacturer-specific?
Are these alternates approved?
Is functional testing required?
Is this BGA package supported?
Is the board intended for lead-free processing?
Are there special reliability requirements?
What is the expected production volume?
These questions demonstrate that the supplier is evaluating the manufacturing problem, rather than merely processing an RFQ.
Ask:
“Who will manage our project from quotation through production?”
Clarify access to:
Sales
Project management
NPI engineering
Procurement
Quality
Production.
For complex products, engineering communication should not become impossible once the purchase order is issued.
Ask:
“Can our engineers communicate directly with your manufacturing engineers during NPI and production?”
Direct technical communication can accelerate:
DFM decisions
Component substitutions
Test development
Root-cause analysis
Engineering changes.
Instead of asking:
“Can you handle BGA?”
ask:
“Can you describe your BGA assembly and inspection process for this type of package?”
Instead of:
“Can you support production?”
ask:
“What is your approach to capacity planning and production ramp for our expected volume?”
Instead of:
“Can you manage component shortages?”
ask:
“What is your process for identifying, communicating and approving component alternatives?”
Specific questions produce more useful answers.
An anonymized DFM report can be particularly useful evidence.
Look for:
Actual engineering observations
Specific risks
Recommended actions
Component-level comments
Manufacturing constraints
Clear status tracking.
A supplier that provides meaningful DFM documentation is demonstrating engineering capability rather than simply claiming it.
You do not necessarily need confidential customer information.
Instead ask for relevant experience with:
Similar PCB complexity
Similar component packages
Similar production volumes
Similar testing requirements
Similar industries
Similar regulatory requirements where applicable.
The important word is:
Similar.
A supplier may have extensive manufacturing experience and still be a poor fit for your specific product.
A strong manufacturing partner should not be afraid to identify potential problems.
For example:
“This component has a long lead time.”
“This PCB feature may require additional fabrication review.”
“Functional testing will require a fixture.”
“This alternate component requires engineering approval.”
These are useful conversations.
A supplier that identifies risk early can help the customer make better decisions.
Before awarding production, conduct a structured review.
Design
PCB files
Fabrication drawings
Assembly drawings
BOM
Pick-and-place data
Gerbers/manufacturing data
Manufacturing
DFM
DFA
Process capability
Assembly process
Testing
Supply Chain
Components
Alternates
Lead times
Critical parts
Commercial
Pricing
Lead time
Tooling
Payment
Logistics.
This review can reveal differences invisible in a simple quotation comparison.
For important production programs, a supplier audit or capability assessment may be appropriate.
Depending on product risk, review:
Manufacturing facilities
Production equipment
Quality systems
Material handling
ESD controls
Traceability
Inspection
Testing
Warehouse practices
Process documentation
Capacity.
The depth of assessment should correspond to:
Product Risk + Production Importance.
For international electronics companies, IP protection can be an important supplier-qualification criterion.
Ask about:
Confidentiality agreements
Access controls
Design-data handling
File access
Employee access
Production-floor controls
Data retention.
Requirements should match the sensitivity of the product.
Industrial, medical, infrastructure and other long-life products require a different supplier-management approach from short-lifecycle products.
Ask:
How is component lifecycle monitored?
How is obsolescence managed?
How are product changes communicated?
Can controlled production continue for several years?
How are legacy BOMs maintained?
If the product will remain in production for years, ask:
Can the supplier support future revisions?
Can it manage engineering changes?
Can it support volume growth?
Can it manage component lifecycle changes?
Can it support ongoing testing?
Can it maintain documentation and traceability?
Can it support future cost optimization?
The best supplier for the first 100 boards may not necessarily be the best partner for the next 100,000.
Ask:
“What ongoing support do you provide after production starts?”
This may include:
Production reporting
Quality reviews
BOM monitoring
Engineering changes
Component lifecycle monitoring
Cost optimization
Capacity planning
Recurring production.
The strongest supplier relationships evolve beyond the first purchase order.

Supplier red flags often appear in scope definition, technical communication, BOM control, testing, documentation and risk management.
Be cautious if a supplier:
1. Gives an unusually low quotation with unclear assumptions
The scope may not be equivalent.
2. Asks no meaningful technical questions
The RFQ may be treated primarily as a price exercise.
3. Has unclear component sourcing
This can create substantial turnkey-PCBA supply-chain risk.
4. Has no clear substitution process
This creates engineering and quality risk.
5. Provides a vague testing scope
“100% tested” is meaningless unless the test method is defined.
6. Cannot explain subcontracted processes
The buyer should understand who owns quality and delivery.
7. Provides lead time without assumptions
Component availability and production capacity can materially affect schedules.
8. Has poor documentation
Weak documentation can become a major problem during NPI and production.
9. Treats BOM sourcing purely as purchasing
Component availability does not necessarily mean technical suitability.
10. Avoids discussing yield or defects
Mature suppliers should understand how manufacturing variation is controlled.
11. Cannot explain revision control
This creates the risk of manufacturing the wrong product configuration.
12. Focuses entirely on price
The cheapest quotation is not necessarily the lowest-risk manufacturing solution.

A structured supplier scorecard makes PCB/PCBA supplier selection more objective, transparent and repeatable.
A structured scorecard reduces the risk of choosing a supplier because of one attractive quotation.
A useful starting framework is:
Evaluation Area | Suggested Weight |
|---|---|
Engineering / DFM / DFT | 15% |
BOM & Component Sourcing | 15% |
Quality & Process Control | 15% |
Assembly Capability | 10% |
Inspection & Testing | 10% |
NPI / Prototype / Pilot Capability | 10% |
Supply-Chain Risk Management | 10% |
Production Scalability | 5% |
Communication / Project Management | 5% |
Commercial Competitiveness | 5% |
These are starting weights, not universal requirements.
For a highly complex product, engineering and testing may deserve greater weight.
For a high-volume product, scalability and supply-chain capability may become more important.
The purpose is not to create a mathematically perfect supplier ranking.
It is to make the decision:
Transparent + Repeatable + Defensible.
Rather than losing the detailed questionnaire from the second article, I recommend retaining it as a practical buyer tool inside the master article.
Technical Capability
Can you manufacture this PCB technology at the required tolerances?
Can you support the required assembly packages?
Can you support BGA/fine-pitch assembly where applicable?
Can you support controlled impedance where required?
What DFM/DFA review is performed?
Quality & Testing
What inspection processes are used?
What testing capabilities are available?
How is traceability maintained?
How are non-conformances handled?
What is your corrective-action process?
How do you measure first-pass yield?
How do you measure rework and scrap?
How do you handle BGA and hidden solder joints?
Who develops and owns test fixtures?
BOM & Supply Chain
How do you validate BOMs?
Who owns BOM procurement?
What component sourcing channels do you use?
How do you manage counterfeit risk?
How do you handle obsolete or unavailable components?
How are alternates proposed and approved?
What component traceability is available?
What happens if a critical component is delayed?
Engineering & NPI
How do you handle NPI?
Who performs the engineering review?
How are process parameters established?
How is first-article or pilot production handled?
How are DFT and test requirements reviewed?
How are engineering changes controlled?
Can you provide an anonymized DFM report?
Production
What production volumes can you support?
What capacity can realistically be allocated to our product?
How do you manage capacity during ramp-up?
How do you handle recurring production?
How do you manage supply interruptions?
What happens if our volume increases suddenly?
What happens if our volume falls?
Commercial & Logistics
What is included and excluded in the quotation?
What tooling/NRE is required and who owns it?
What are the MOQ, payment, delivery and shipping terms?
Who will own our project from engineering through production?
This combines the detailed questions from both original articles without maintaining two competing checklists.
If a sourcing team does not have time to ask all 40 questions during the first discussion, start here:
What exactly is included in your turnkey PCBA service?
How do you validate and manage our BOM?
How do you handle component shortages and alternates?
What DFM and DFT support do your engineers provide?
How do you manage NPI and pilot production?
What inspection and testing capabilities do you have?
How do you measure and control production quality and yield?
How do you manage engineering changes and revision control?
What production capacity can you realistically allocate to our product?
Who will own our project from engineering through production?
These provide a surprisingly effective first-level supplier screen.
For an even faster initial screen, ask:
1. Can this supplier reliably manufacture our design?
Technical fit
2. Can they control quality consistently?
Manufacturing reliability
3. Can they secure and manage our BOM?
Supply-chain capability
4. Can they support us from prototype through production?
Lifecycle capability
5. Will they provide predictable total cost and delivery?
Commercial and operational fit
If the answer to any of these remains unclear, the supplier requires further evaluation.
International manufacturing introduces another layer of supplier qualification.
Ask:
Do you regularly support international customers?
Can you manage export documentation?
What shipping terms do you support?
How do you handle international quality issues?
Can you communicate with engineering and procurement teams across time zones?
How do you handle urgent production changes?
Can you support recurring export shipments?
How are production and shipment updates communicated?
International manufacturing involves coordination, documentation and predictability—not just production.
For buyers evaluating India—or any manufacturing geography—the same principle applies:
Do not select a manufacturing destination solely because of country-level advantages.
Evaluate the individual supplier's:
Engineering depth
Manufacturing capability
Component sourcing
Quality systems
Testing
NPI process
Production scalability
Export experience
Communication.
A capable Indian PCBA partner can potentially provide an attractive combination of manufacturing capability, engineering support and supply-chain flexibility.
But supplier qualification must determine whether that potential translates into a suitable manufacturing relationship for the specific product.
Before selecting a supplier, confirm:
Technical
☐ PCB technology matches requirements☐ Assembly capability matches component packages☐ DFM/DFA support available☐ DFT support available☐ Required testing available☐ NPI capability demonstrated
Quality
☐ Quality system reviewed☐ Inspection process understood☐ Test process understood☐ Traceability understood☐ Corrective-action process understood☐ Yield/rework controls understood
BOM & Components
☐ BOM validation process established☐ Critical components identified☐ Lifecycle risks reviewed☐ Alternate approval process defined☐ Sourcing channels understood☐ Counterfeit-risk controls understood
Production
☐ Prototype capability confirmed☐ NPI process reviewed☐ Pilot capability assessed☐ Production capacity evaluated☐ Ramp capability assessed☐ Lead time validated☐ Recurring production capability confirmed
Commercial
☐ Quote scope normalized☐ Assumptions and exclusions understood☐ NRE/tooling identified☐ MOQ understood☐ Component ownership defined☐ Logistics understood☐ Payment terms reviewed☐ Quality/warranty responsibility understood
Relationship
☐ Communication is responsive☐ Technical discussions are meaningful☐ Project owner identified☐ Engineering access available☐ Escalation process is clear☐ Long-term production fit is credible
These are directly aligned with the qualification checklist in the source material.

The goal of supplier qualification is not zero risk—it is understanding and controlling the risks that matter.
Every supplier introduces some combination of:
Technical risk
Quality risk
Component risk
Supply-chain risk
Delivery risk
Commercial risk
Communication risk
Scale-up risk.
The objective is not necessarily to find a supplier with zero risk.
That is rarely realistic.
The objective is to determine:
Which risks exist, how significant are they, and does the supplier have credible processes to manage them?
This is a much stronger basis for supplier selection than price alone.
A strong manufacturing partner should be able to connect:
Engineering
↓
DFM/DFA + DFT
↓
BOM & Supply Chain
↓
Component Validation
↓
PCB Fabrication
↓
PCBA
↓
Inspection & Testing
↓
NPI
↓
Production Ramp
↓
Ongoing Manufacturing Support
The value is not simply in having machines.
It is in being able to manage the complete manufacturing process reliably and transparently.

A true turnkey PCBA capability connects engineering, sourcing, manufacturing, quality, testing and delivery into one controlled system.
By the end of qualification, you should have evidence that the supplier can manage:
Engineering
Design → DFM → DFT
Supply Chain
BOM → Sourcing → Availability → Alternates
Manufacturing
PCB → SMT/THT → Reflow → Process Control
Quality
SPI/AOI/X-ray → Inspection → Corrective Action
Testing
Programming → ICT/Flying Probe → Functional Testing
NPI
Prototype → Pilot → Yield → Production Release
Production
Capacity → Scheduling → Traceability → Delivery
This is what turns “turnkey” from a marketing term into an actual manufacturing capability.
For international electronics buyers, supplier selection becomes easier when PCB fabrication, component sourcing, PCBA, testing and production support are evaluated as parts of one connected manufacturing requirement.
At QUADRIONIX, the objective is to support that decision with a manufacturing approach that connects:
→ PCB
→ BOM
→ Components
→ Assembly
→ Testing
→ Production
rather than treating each requirement as an isolated transaction.
For turnkey PCBA, that philosophy extends across:
→ Engineering
→ BOM & Supply Chain
→ PCB Fabrication
→ Assembly
→ Inspection
→ Testing
→ NPI
→ Production
→ Quality
→ Delivery.
The goal is not simply to answer:
“Who can manufacture our board?”
It is:
“Who can manufacture our board reliably, manage the associated supply-chain risks and support us as the product moves into production?” Evaluate the design. Qualify the supplier. Understand the risks. Validate the economics. Then scale with confidence.
Evaluating a PCB/PCBA manufacturing supplier should be treated as a structured engineering and procurement decision.
The strongest evaluation considers:
Technical Capability
Can the supplier manufacture the actual design?
Quality
Can it consistently meet the required standards and specifications?
BOM & Component Sourcing
Can it secure, validate and manage the required components?
Engineering & NPI
Can it help move the product from design into repeatable production?
Testing
Can it detect the failure modes relevant to the product?
Supply Chain
Can it manage component and production continuity?
Capacity
Can it support the required production volume and future ramp?
Delivery
Can it meet the complete schedule—not merely the PCB fabrication lead time?
Commercial Transparency
Can the buyer clearly understand total cost, assumptions and exclusions?
Long-Term Fit
Can the supplier support the product throughout its manufacturing lifecycle?
The right supplier is therefore not necessarily:
the company with the lowest quotation.
It is the supplier that provides the strongest combination of:
Technical capability + Quality + Engineering support + Supply-chain reliability + Delivery + Commercial transparency.
That is what turns a PCB manufacturer into a manufacturing partner.
Upload your Gerber files & BOM for automated DFM review, engineering feedback, and guaranteed delivery timelines.
