A Practical Guide for Engineering, Procurement and Sourcing Teams Evaluating PCB and PCBA Manufacturing Quotes

When an electronics company requests quotations from several PCB or PCBA manufacturers, the result can sometimes look deceptively simple.
Supplier A:
$8.40
Supplier B:
$10.20
Supplier C:
$13.10
At first glance, Supplier A appears to be the obvious choice.
But is it?
Not necessarily.
A PCB/PCBA quotation is only meaningful when the three suppliers are quoting the same technical scope, material specification, component scope, testing requirements, commercial terms and delivery conditions.
A lower quotation can sometimes represent a genuine cost advantage.
It can also represent:
different PCB materials
different copper specifications
different component assumptions
different testing scope
excluded tooling
excluded NRE
different component sourcing channels
different yield assumptions
different shipping terms
different lead-time assumptions
incomplete assembly scope
This is why experienced sourcing teams do not simply ask:
"Who is cheapest?"
They ask:
"Which supplier provides the best combination of technical compliance, quality, delivery, supply-chain reliability and total landed cost for the required scope?"
Two manufacturers can receive the same RFQ and return substantially different prices.
That does not automatically mean that one supplier is overcharging.
The difference may come from how each supplier interprets the requirement.
For example, a PCBA quotation may depend on:
PCB layer count
board dimensions
PCB material
copper weight
surface finish
PCB quantity
component count
SMT placements
THT components
component sourcing
component availability
alternate component assumptions
stencil requirements
programming
testing
inspection
packaging
logistics
Therefore, before comparing prices, establish whether the quotations are actually like-for-like.

This is the single most important step.
Create a comparison table with the same requirements for every supplier.
At minimum, normalize:
PCB
Layer count
Dimensions
Material
Thickness
Copper weight
Surface finish
Solder mask
Controlled impedance
Via requirements
Quantity
Assembly
SMT
THT
Mixed technology
Number of placements
Stencil
Programming
Testing
Inspection
Cleaning
Packaging
Components
Customer-supplied components
Supplier-sourced components
Approved manufacturers
Approved alternates
MOQ
Lead time
Excess inventory assumptions
Commercial
Tooling
NRE
Freight
Taxes/duties
Payment terms
Quote validity
Warranty
Delivery terms
Only after normalizing these items does price comparison become meaningful.
A PCB fabrication quotation should be reviewed line by line.
Check whether the price includes:
PCB fabrication
tooling
engineering/NRE
electrical testing
impedance testing
coupons
special packaging
documentation
freight
For example, one supplier may include tooling within the unit price while another lists tooling separately.
Both quotations may ultimately have similar total costs.
The headline unit price alone does not tell the full story.
Material differences can create significant quotation differences.
Check:
FR-4 specification
Tg
laminate brand/type where specified
board thickness
copper weight
dielectric construction
high-speed material requirements
specialty material requirements
A quotation for a standard FR-4 board should not be directly compared against one using a specialized high-speed laminate unless the specification requires it.
Likewise, simply writing:
"FR-4"
may not provide enough information for a demanding application.
The material specification should match the engineering requirement.
Common PCB surface finishes include:
HASL
lead-free HASL
ENIG
OSP
immersion silver
immersion tin
They have different cost and application implications.
Therefore, if Supplier A quotes HASL and Supplier B quotes ENIG, the prices are not directly comparable.
The buyer should first establish:
What surface finish does the design actually require?
Copper weight affects both performance and manufacturing cost.
Check whether the quotation assumes:
1 oz copper
2 oz copper
heavier copper
different inner/outer layer copper specifications
A supplier quoting lower-cost standard copper construction may not be equivalent to another supplier quoting heavier copper required by the design.
If the PCB contains controlled-impedance traces, confirm whether the quotation includes:
impedance-controlled stack-up
impedance calculations
test coupons
impedance testing
specified tolerance
A low-cost quotation that does not include the required impedance-control process should not be compared directly with a quotation that does.

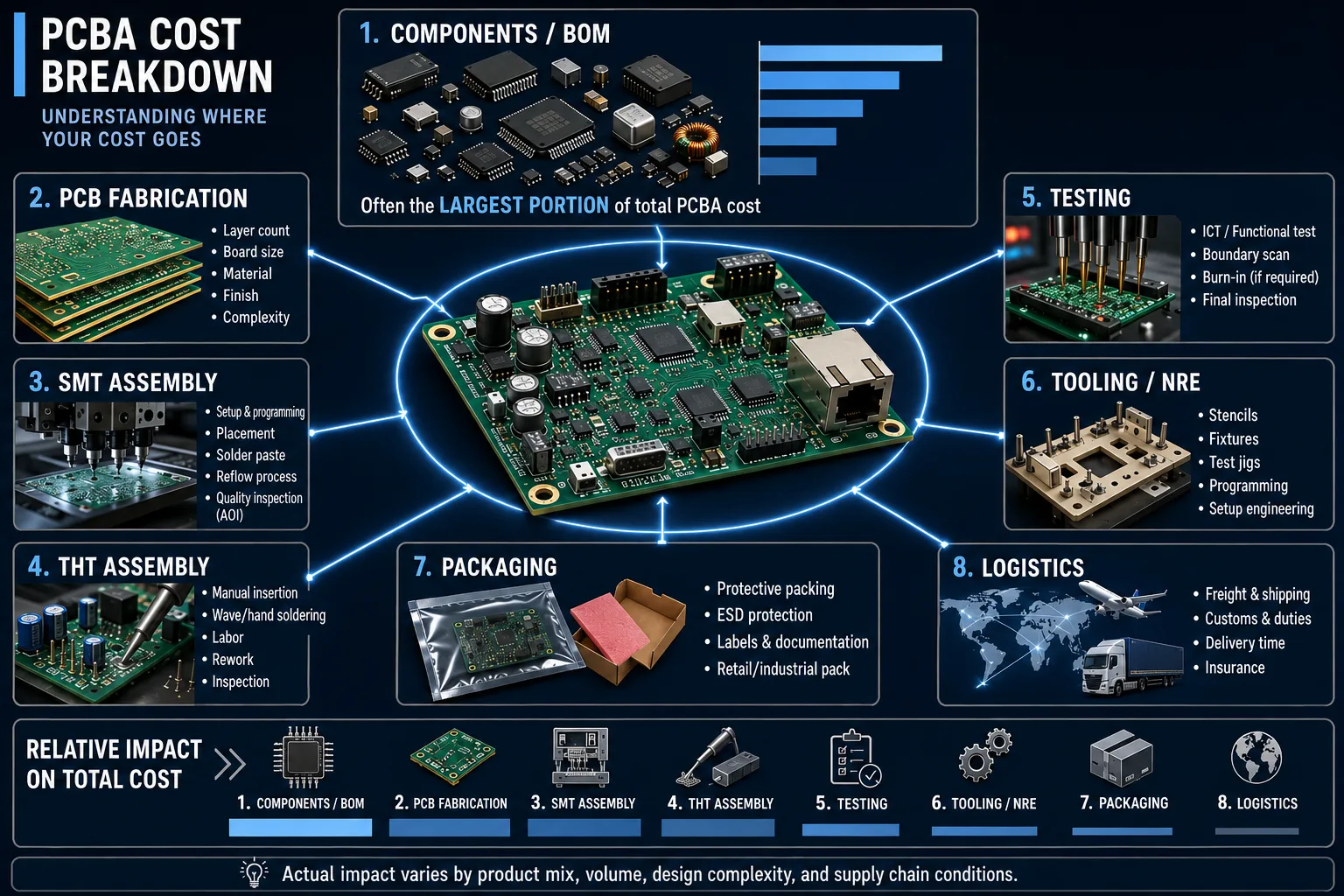

A PCBA quotation contains multiple cost layers.
A useful model is:
PCBA Cost = PCB + Components + Assembly + Testing + Tooling/NRE + Logistics + Other Services
But each of those categories can contain additional assumptions.
For example:
Components
Component unit price
MOQ
Supplier
Freight
Taxes/duties
Excess inventory
Alternate components
Assembly
SMT placements
THT insertions
Machine setup
Labour
Rework assumptions
Testing
AOI
X-ray
ICT
Flying probe
Functional testing
This is why a PCBA quotation requires significantly more scrutiny than a bare-board quotation.
For many PCB assemblies, the PCB itself represents only a fraction of the total product cost.
The BOM can be much more significant.
Therefore, compare:
component unit prices
manufacturer part numbers
quantity breaks
availability
lead times
authorized vs independent sourcing
alternates
component condition
A supplier offering a lower PCBA price because it assumes cheaper or different components may not be providing the same product.
One of the most important questions to ask is:
"Are you quoting exactly the same BOM revision?"
Confirm:
BOM revision
manufacturer part number
quantity per board
approved alternates
DNP components
reference designators
component lifecycle status
Even a single major component substitution can materially affect the quotation.

"Equivalent" does not necessarily mean "identical."
An alternate component can have differences in:
electrical characteristics
tolerance
package
thermal performance
qualification
lifecycle
reliability
Therefore:
A lower PCBA quotation achieved through unapproved component substitution is not necessarily a lower-cost equivalent solution.
The alternate must be technically validated and approved.
When components are included in a turnkey PCBA quotation, ask how they will be sourced.
Possible channels include:
manufacturer
authorized distributor
independent distributor
broker
excess inventory
These sourcing channels can have different implications for:
authenticity
traceability
availability
price
lead time
warranty
The lowest component price should not automatically win.
For critical components, sourcing integrity may be more important than a small unit-price difference.
For important assemblies, ask whether the supplier can provide appropriate traceability.
Depending on the product, this may include:
manufacturer
manufacturer part number
lot/batch
date code
supplier
purchase documentation
certificates where applicable
Traceability becomes particularly important for:
industrial electronics
automotive applications
medical products
aerospace/defense-related applications
safety-critical systems
The exact requirements depend on the product and applicable standards.
A PCBA quotation should clearly identify testing scope.
Possible services include:
AOI
X-ray
ICT
flying probe
functional testing
programming
visual inspection
Do not assume that "tested PCBA" means the same thing across suppliers.
Ask:
What exactly is tested, how is it tested, and what is included in the quoted price?
Functional testing can require:
test fixtures
test software
programming
test adapters
dedicated equipment
engineering development
Therefore, if one supplier includes functional testing and another quotes only AOI, the prices are not directly comparable.
Common additional costs may include:
SMT stencil
test fixture
programming fixture
tooling
engineering/NRE
special jigs
custom packaging
Ask suppliers to separate:
One-time costs
from
Recurring unit costs.
This makes supplier comparison much easier.
A prototype quotation should not automatically be compared with a mass-production quotation.
Prototype quantities often have:
smaller purchasing volumes
higher setup cost per board
higher component cost
dedicated engineering effort
more manual operations
Production pricing benefits from:
volume purchasing
optimized setup
automated assembly
established test processes
better material utilization
Therefore, compare quotations at the same quantity and production stage.
Request pricing at meaningful production volumes.
For example:
Quantity | Supplier A | Supplier B | Supplier C |
|---|---|---|---|
Prototype | — | — | — |
100 | — | — | — |
500 | — | — | — |
1,000 | — | — | — |
5,000 | — | — | — |
The supplier that is cheapest at 100 units may not be cheapest at 5,000.
This is particularly relevant when evaluating long-term manufacturing partnerships.

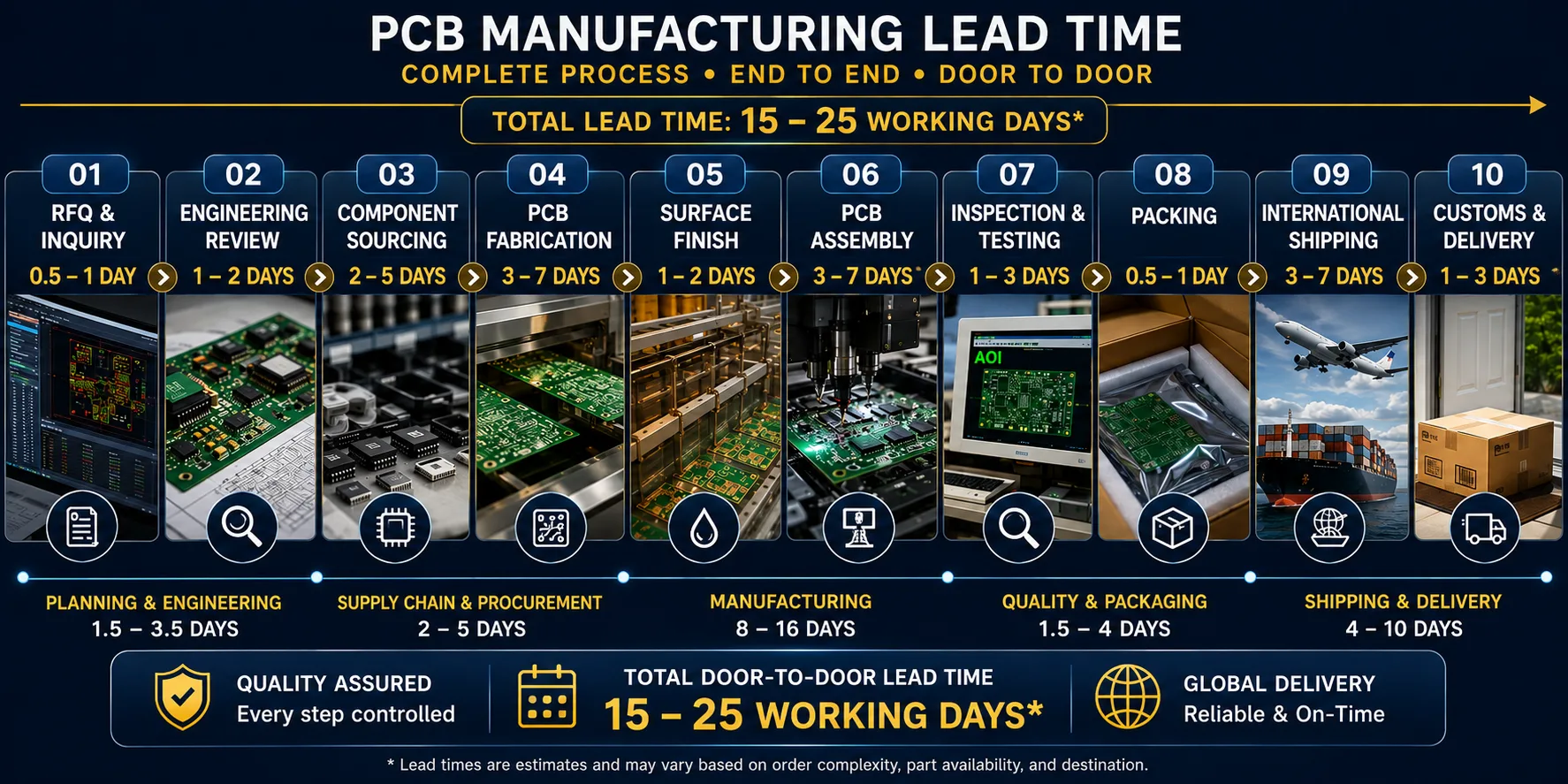

A quotation should not be evaluated only on price.
Compare:
engineering lead time
PCB fabrication lead time
component procurement lead time
assembly lead time
testing lead time
shipping time
total door-to-door lead time
A supplier offering a lower unit price but requiring substantially longer delivery may create higher overall business cost.
Two suppliers can quote the same unit price while offering very different landed costs.
Check:
EXW
FOB
CIF
DAP
DDP
freight
insurance
customs
duties
local delivery
The exact commercial structure should be clearly documented.
For international buyers, compare the landed cost, not simply the factory price.
Depending on the sourcing country and transaction structure, the buyer may incur:
import duties
VAT/GST
customs charges
brokerage
local handling
freight
These should be identified separately where applicable.
A quotation that appears cheaper at the factory level may not remain cheaper after import and logistics costs are included.
Compare:
advance payment
deposit + balance
milestone payments
credit terms
payment before shipment
Payment terms can materially affect working capital.

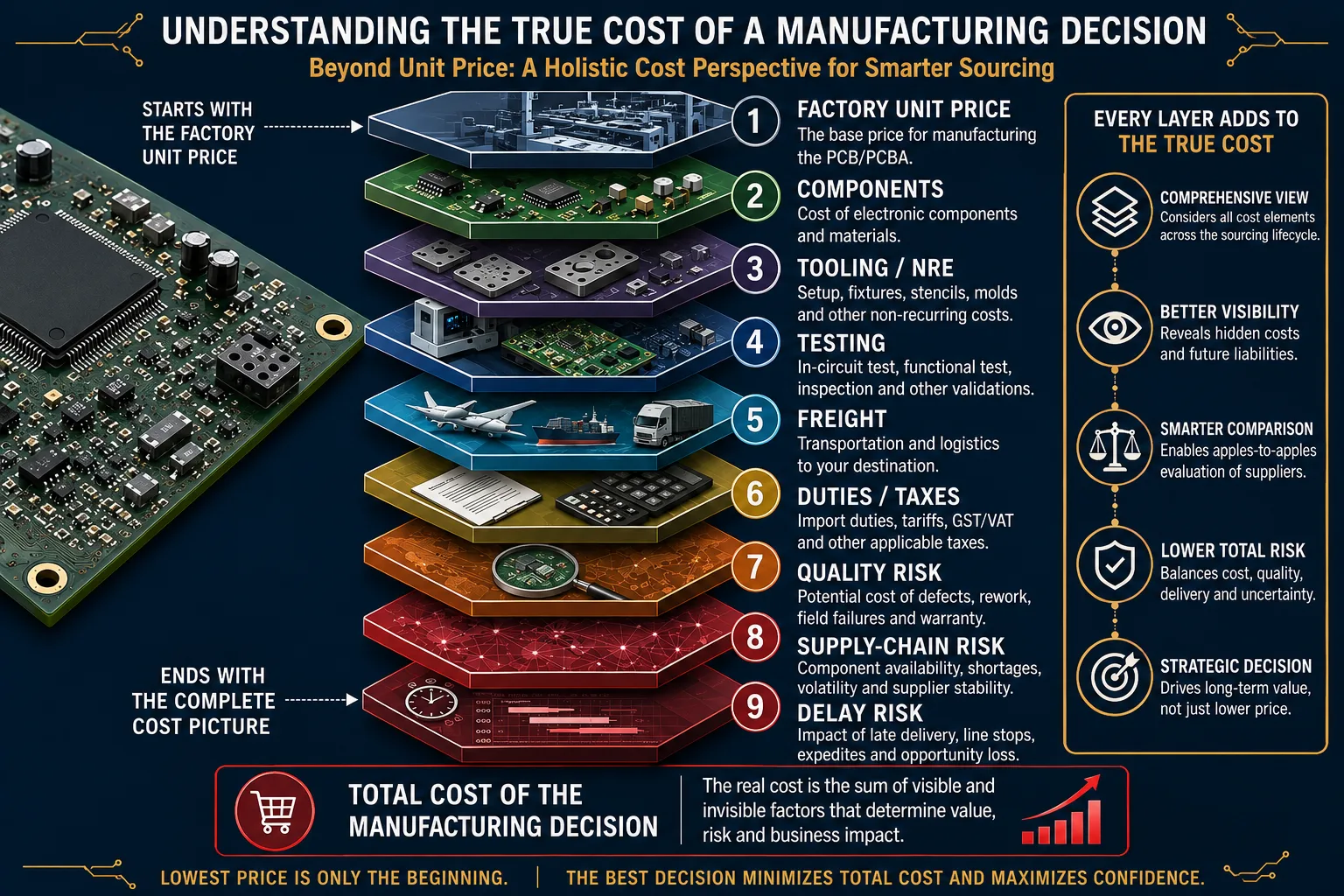

Therefore, the best quotation is not necessarily the one with the lowest unit price.
It may be the quotation offering the best overall combination of:
Price + risk + payment structure + delivery + quality.
Component pricing can change rapidly.
Therefore, a PCBA quotation should state:
quotation validity
component-price assumptions
availability assumptions
lead-time assumptions
A quote valid for a short period may be entirely reasonable for a component-heavy assembly.
The buyer should understand what happens when the quote expires.
This is especially important for production programs.
Ask:
What happens if a quoted component becomes unavailable between quotation and purchase?
Possible approaches include:
customer approval required
approved alternate
engineering review
supplier proposes replacement
procurement waits for original part
The supplier's change-control process matters.
Two quotations may differ because the suppliers operate different quality-control processes.
Evaluate:
incoming inspection
SPI
AOI
X-ray
electrical testing
functional testing
process controls
traceability
final inspection
quality documentation
The objective is not necessarily to select the supplier with the greatest number of inspections.
It is to select the process appropriate for the product's risk.
Ask how the supplier handles:
defects
rework
scrap
replacement
yield issues
For high-volume production, even a small difference in manufacturing yield can materially affect total cost.
This is another reason that:
Quoted unit price ≠ true manufacturing cost.
Clarify:
warranty period
defect responsibility
replacement policy
rework responsibility
shipping responsibility for rejected products
root-cause analysis
corrective-action process
These terms can become extremely important when production volumes increase.

A supplier should not be evaluated solely as a factory.
For complex PCBA programs, assess whether the supplier can support:
DFM
DFA
BOM review
component validation
stack-up review
test strategy
NPI
engineering changes
production ramp
A supplier that identifies a manufacturability problem before production can create considerably more value than a supplier that simply provides a lower quotation.
Ask:
What exactly does the supplier manufacture themselves, and what is externally sourced?
Understand the supplier's capabilities across:
PCB fabrication
PCB assembly
component sourcing
testing
programming
box build
cable assembly
packaging
This helps establish who is actually responsible for each part of the manufacturing chain.
A manufacturing company may use qualified partners for certain processes.
That is not automatically a weakness.
The important question is whether the supplier maintains control over:
quality
specifications
traceability
delivery
inspection
corrective action
For the buyer, the important issue is not simply:
"Is every process performed under one roof?"
It is:
"Who owns the manufacturing outcome and who is accountable to me?"
A quotation is the beginning of the relationship.
During production, the buyer may need decisions on:
component substitutions
engineering changes
material availability
production delays
quality issues
test failures
Evaluate whether the supplier has a structured process for:
RFQ clarification
engineering review
change approval
escalation
documentation
Poor communication can create costs that never appear in the original quotation.
A spreadsheet is useful.
But supplier evaluation should combine:
Commercial data + technical evaluation + operational evidence.
For example:
Commercial
Unit price
NRE
tooling
freight
payment terms
Technical
material
process capability
testing
DFM
component sourcing
Operational
capacity
lead time
communication
quality system
NPI support
This creates a much more reliable supplier decision.
A sourcing team can create a weighted scorecard.
Evaluation Area | Suggested Consideration |
|---|---|
Technical compliance | Does the quotation meet the exact specification? |
PCB quality | Material, fabrication and process capability |
PCBA quality | Assembly and inspection capability |
Component sourcing | Availability, authenticity and traceability |
Testing | Required testing included? |
Lead time | Total production + logistics time |
Total landed cost | Complete cost to buyer |
NRE/tooling | Clearly identified? |
Engineering support | DFM, BOM, NPI and change support |
Supply-chain resilience | Alternatives and continuity |
Communication | Responsiveness and clarity |
Commercial terms | Payment, validity and warranty |
The weighting should reflect the product.
A safety-critical product should not necessarily give price the highest weighting.
Suppose three suppliers quote:
Supplier A | Supplier B | Supplier C | |
|---|---|---|---|
PCBA unit price | $10.20 | $10.80 | $11.40 |
Testing | Basic | Required | Required |
Components | Mixed assumptions | Exact BOM | Exact BOM |
Tooling | Extra | Included | Included |
Freight | Extra | Extra | Included |
Lead time | 7 weeks | 5 weeks | 4 weeks |
Supplier A appears cheapest.
But once the scope is normalized, Supplier C may offer the strongest overall proposition.
This is why quotation comparison should focus on:
Total cost of ownership and manufacturing risk.
Not merely the first number on the quotation.
A quotation dramatically below the market range deserves investigation.
Ask:
Is the same material being used?
Is the same PCB construction being quoted?
Are components identical?
Are approved manufacturers being followed?
Is testing included?
Is tooling included?
Is freight excluded?
Are taxes excluded?
Is the quoted lead time realistic?
Are component availability assumptions different?
A very low quote may be legitimate.
But it should be understood before being accepted.
Technical
Are you quoting the exact PCB specification?
Is the material specification identical?
Are all controlled-impedance requirements included?
Are all assembly requirements included?
Are approved components being used?
BOM
Are you quoting the exact BOM revision?
Are all manufacturer part numbers available?
Are alternates included?
Are any components subject to availability assumptions?
How are substitutions handled?
Testing
What inspection is included?
Is AOI included?
Is X-ray included where required?
Is functional testing included?
Are fixtures/tooling included?
Commercial
Is NRE included?
Is stencil cost included?
Is freight included?
What are the payment terms?
How long is the quotation valid?
Delivery
What is the PCB fabrication lead time?
What is the component procurement lead time?
What is the assembly lead time?
What is the total door-to-door lead time?
Quality
What happens if the delivered product fails inspection?
What is the corrective-action process?
What traceability is available?
What warranty is provided?

The most useful way to think about supplier quotations is:
Headline Price
↓
+ Missing/Additional Costs
↓
+ Logistics
↓
+ Quality Risk
↓
+ Supply-Chain Risk
↓
+ Delay Risk
↓
+ Engineering/Management Cost
↓
True Cost of the Manufacturing Decision
A supplier with a slightly higher quoted price may produce a lower overall business cost if it delivers:
better quality
predictable supply
stronger engineering support
better component control
shorter lead times
fewer production problems
A strong quotation should make it relatively easy for the buyer to understand:
What is included
PCB
components
assembly
testing
tooling
packaging
What is excluded
freight
taxes
special testing
engineering changes
special components
What assumptions were made
material
BOM
quantities
component availability
delivery
What happens if assumptions change
component shortage
material shortage
engineering change
quantity change
Transparency is itself a useful supplier-selection signal.
A complicated quotation is not necessarily a bad quotation.
PCB/PCBA manufacturing is technically complicated.
But the buyer should still be able to determine:
What am I paying for?
What am I receiving?
What assumptions were made?
What could change the price?
Who is responsible if something goes wrong?
If those questions cannot be answered clearly, the quotation requires further clarification before approval.
Before selecting a supplier:
Technical Scope
Same PCB specification
Same material
Same copper
Same surface finish
Same stack-up
Same assembly scope
Same testing requirements
BOM
Same BOM revision
Same manufacturer part numbers
Same quantities
Alternates identified
Component availability checked
Sourcing channel understood
Cost
PCB cost
Component cost
Assembly cost
Testing
Tooling
NRE
Packaging
Freight
Duties/taxes where applicable
Delivery
Fabrication lead time
Component lead time
Assembly lead time
Testing time
Shipping time
Total door-to-door lead time
Quality
Inspection scope
Test scope
Traceability
Warranty
Corrective-action process
Supplier Capability
DFM support
BOM validation
NPI support
Engineering communication
Production capacity
Supply-chain support
Comparing PCB/PCBA suppliers purely on unit price is one of the easiest ways to make a sourcing decision look objective while actually leaving major variables unexamined.
A better approach is:
1. Normalize the technical scope
Make sure every supplier is quoting the same product.
2. Validate the BOM
Confirm exact manufacturer part numbers, quantities and approved alternates.
3. Separate recurring and one-time costs
Understand tooling, stencil, fixtures and NRE.
4. Compare testing
Make sure the same inspection and test requirements are included.
5. Calculate total landed cost
Include logistics and applicable import-related costs.
6. Compare lead time
Look at the complete journey from RFQ to delivered product.
7. Evaluate quality and engineering capability
A supplier should be able to manufacture the product reliably—not merely quote it cheaply.
8. Evaluate supply-chain risk
Component availability and alternate sourcing can be just as important as PCB fabrication cost.
9. Look at the long-term relationship
The right manufacturing partner should be able to support prototype, NPI, production ramp and ongoing engineering changes.
The goal is therefore not:
Find the cheapest PCB/PCBA quotation.
It is:
Find the supplier offering the strongest combination of technical compliance, quality, delivery, supply-chain reliability and total cost for the product's requirements.
That is the difference between buying a PCB and making a sound manufacturing decision.
At QUADRIONIX, the objective of an RFQ is more than generating a number.
A technically meaningful quotation should connect the customer's:
PCB design → BOM → component availability → manufacturing requirements → assembly → testing → delivery
into one coherent manufacturing scope.
For international buyers, this can make supplier comparison considerably easier because technical and commercial assumptions are clarified before production begins.
Upload your Gerber files & BOM for automated DFM review, engineering feedback, and guaranteed delivery timelines.
